Timiskaming Wind Project

News Project information Market Opportunity / Provincial Context Project Development Area (MAP) Environmental Permitting Schedule Community Benefits Vendors and Suppliers Contact

ABO Energy is proposing the development of the Timiskaming Wind Project, a utility-scale wind energy project with an installed capacity of 100 to 150 megawatts (MW). The Project is designed to contribute clean, renewable energy to Ontario’s transmission grid and support provincial decarbonization goals.

Development
Current status
Permitting process
Construction
Operation

News

October 2025: Update Submission Timeline to LT2 Window 2

ABO Energy has decided not to proceed with submitting the Timiskaming Wind Project into the IESO Long Term 2 (LT2) Window 1, which had a submission deadline of October 16th, 2025. Instead, ABO Energy will further strengthen our project by collecting additional wind data and advancing project development. In addition, we will continue to engage the public and First Nations to build trust, disseminate accurate information and receive feedback. Our intention will be to submit into LT2 Window 2, which is tentatively scheduled for Summer 2026.

Open House on 7th August 2025

ABO Energy will be hosting an Open House on Thursday, August 7th at Riverside Place in New Liskeard, located at 55 Riverside Drive. The event will run from 6:00 pm to 8:30 pm and will have project experts in attendance to discuss topics and answer questions relating to:

  • Project Details
  • Wind Technology and Industry
  • Schedule
  • Environment
  • Regulatory Process
  • Consultation
  • Community Benefits

Please note that the Open House will not be in a ‘presentation’ format. Instead, attendees can walk around the room at their own pace and discuss topics of specific interest with project personnel. Refreshments will be provided.

Posters from our Open House on August 7, 2025

You will find a PDF version from all posters under Download.

Please find our English and French Posters below.
You can click on a poster to see a larger version.

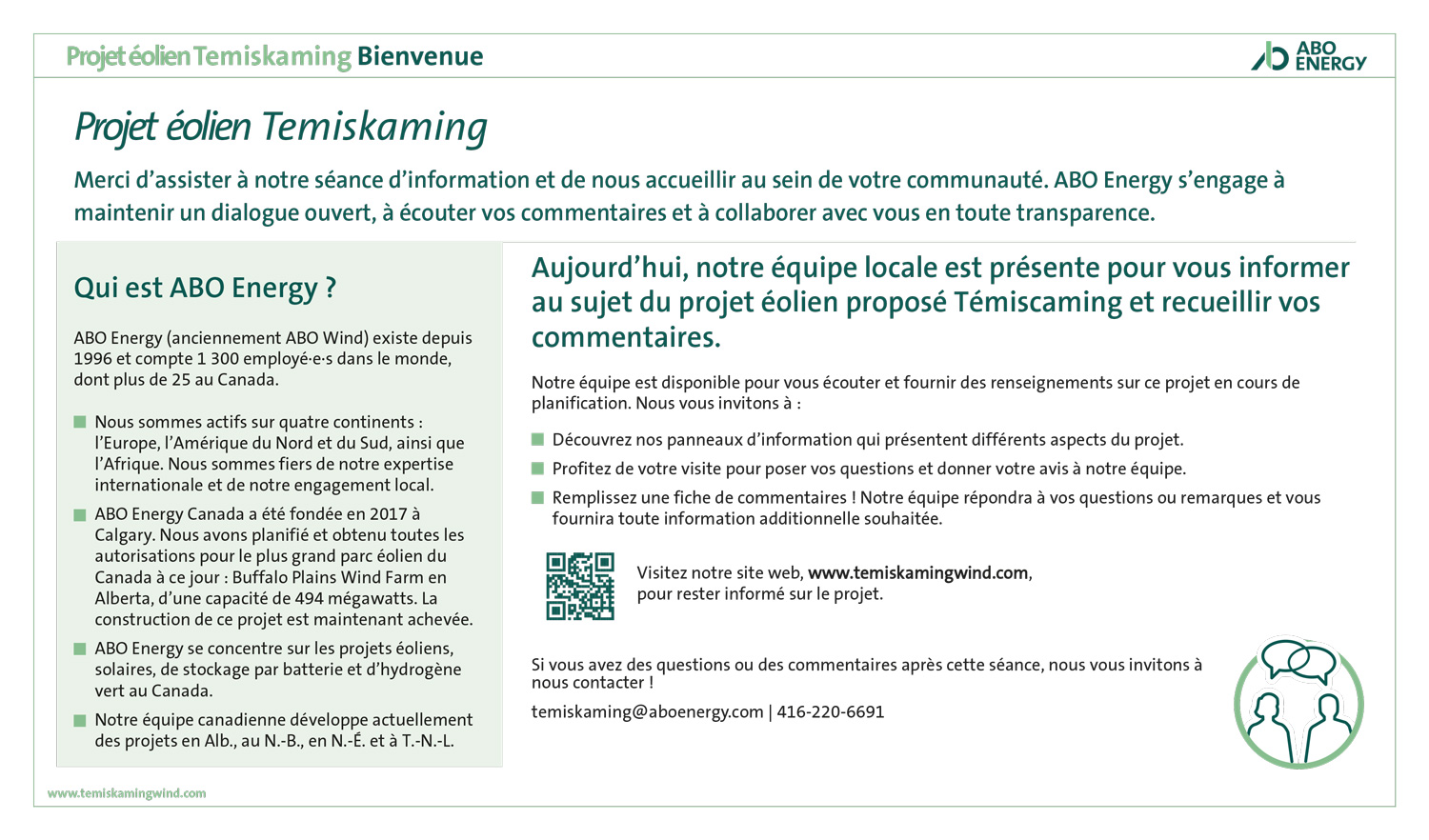

Welcome to the Open House
Welcome to the Open House
Bienvenue aux portes ouvertes
Bienvenue aux portes ouvertes
ABO Energy Highlights
ABO Energy Highlights
Faits saillants ABO Energy
Faits saillants ABO Energy
Temiskaming Wind Project
Temiskaming Wind Project
Projet éolien Temiskaming
Projet éolien Temiskaming

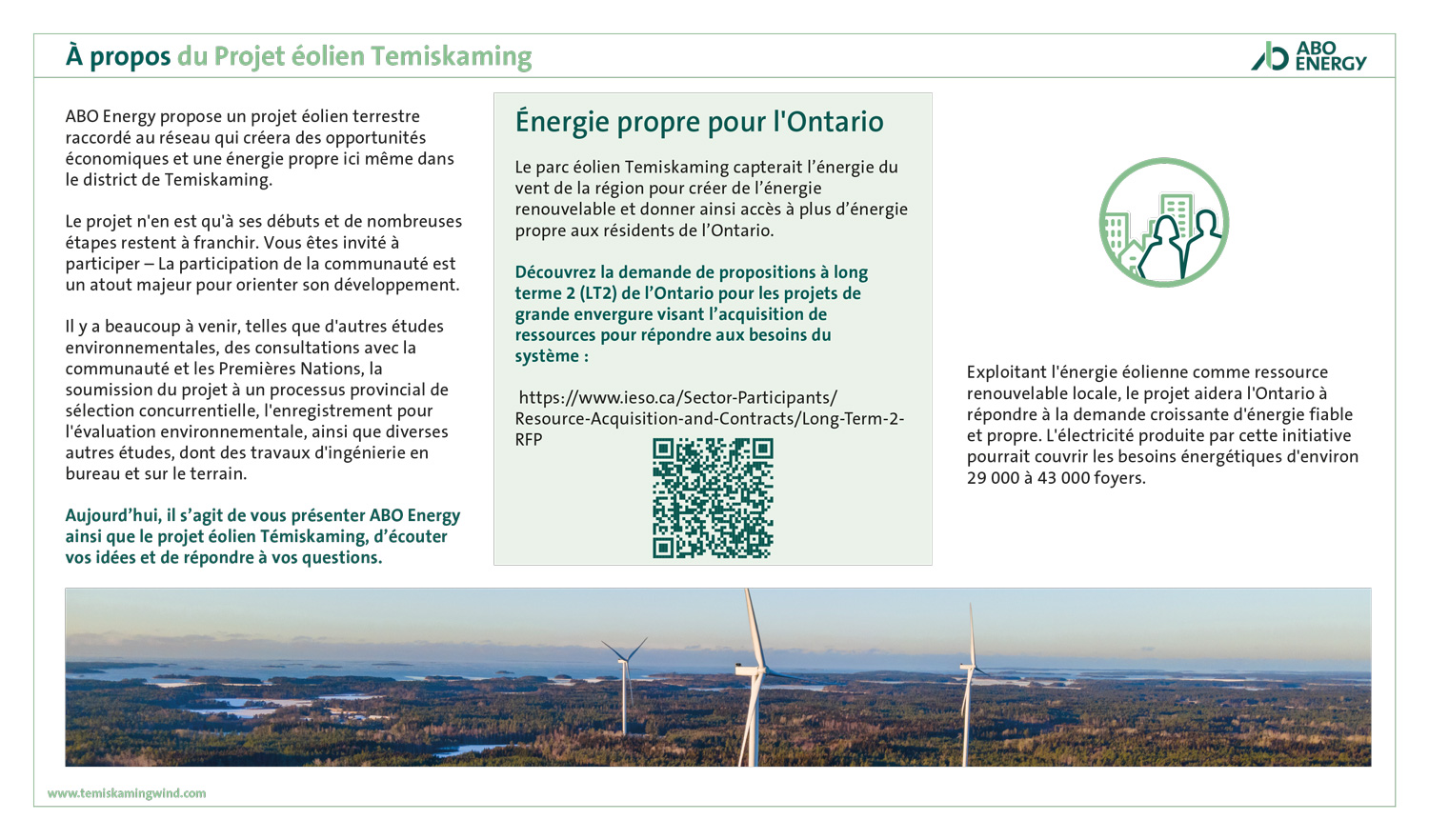

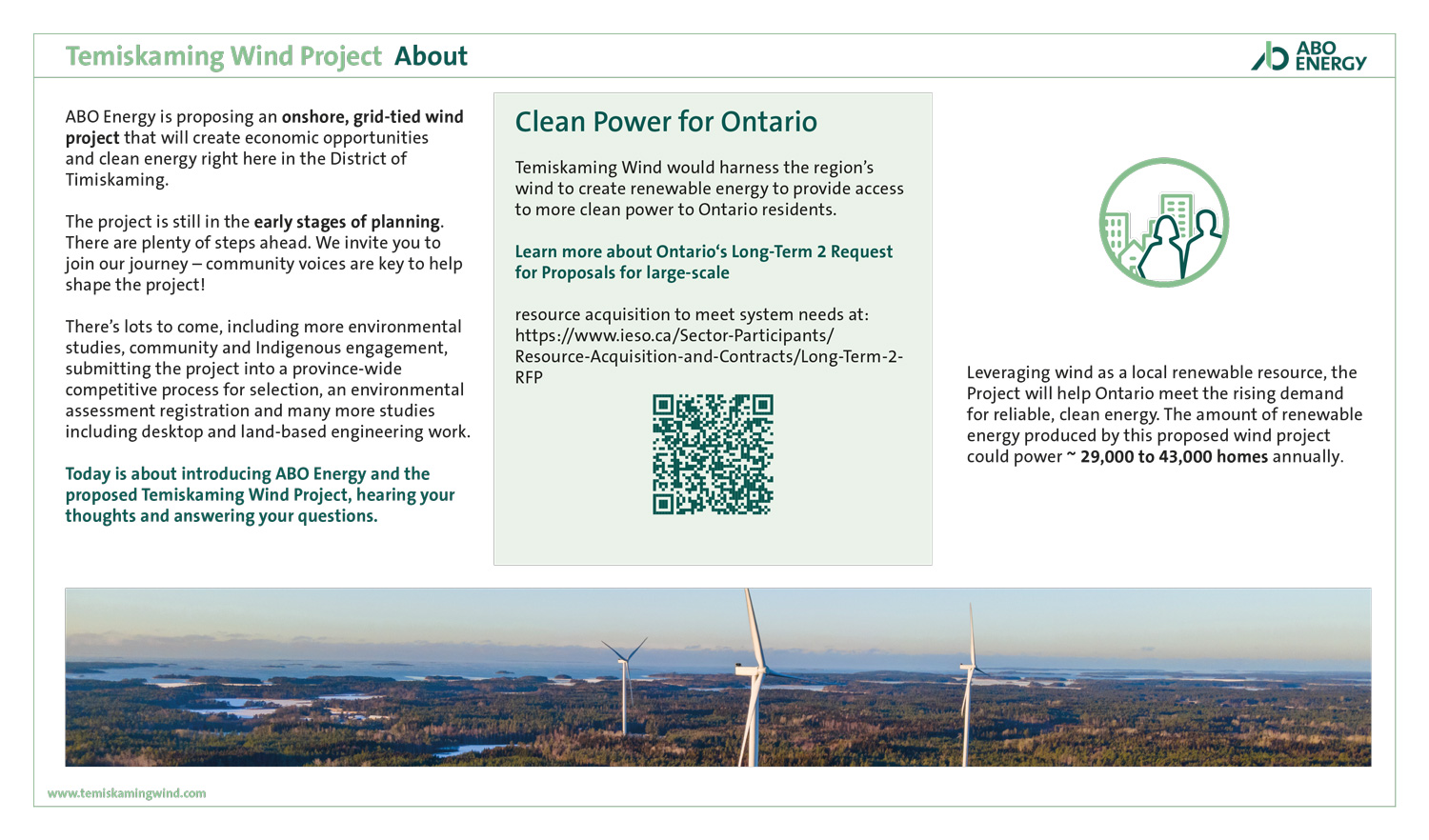

About the Project
About
À propos du Projet
À propos du Projet éolien Temiskaming

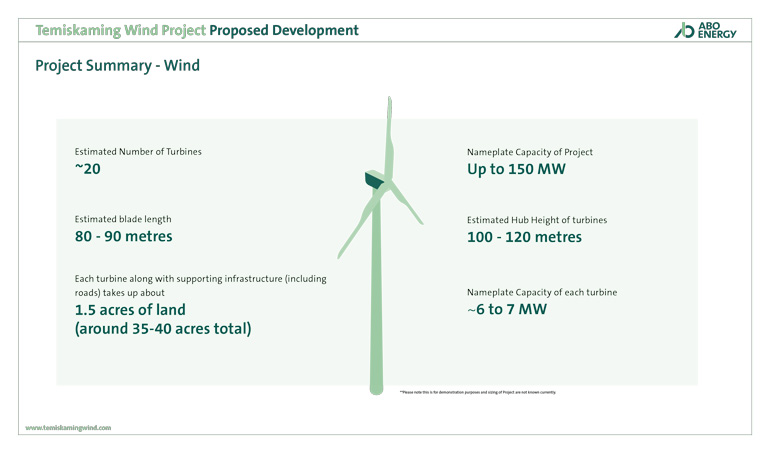

Proposed Development
Proposed Development

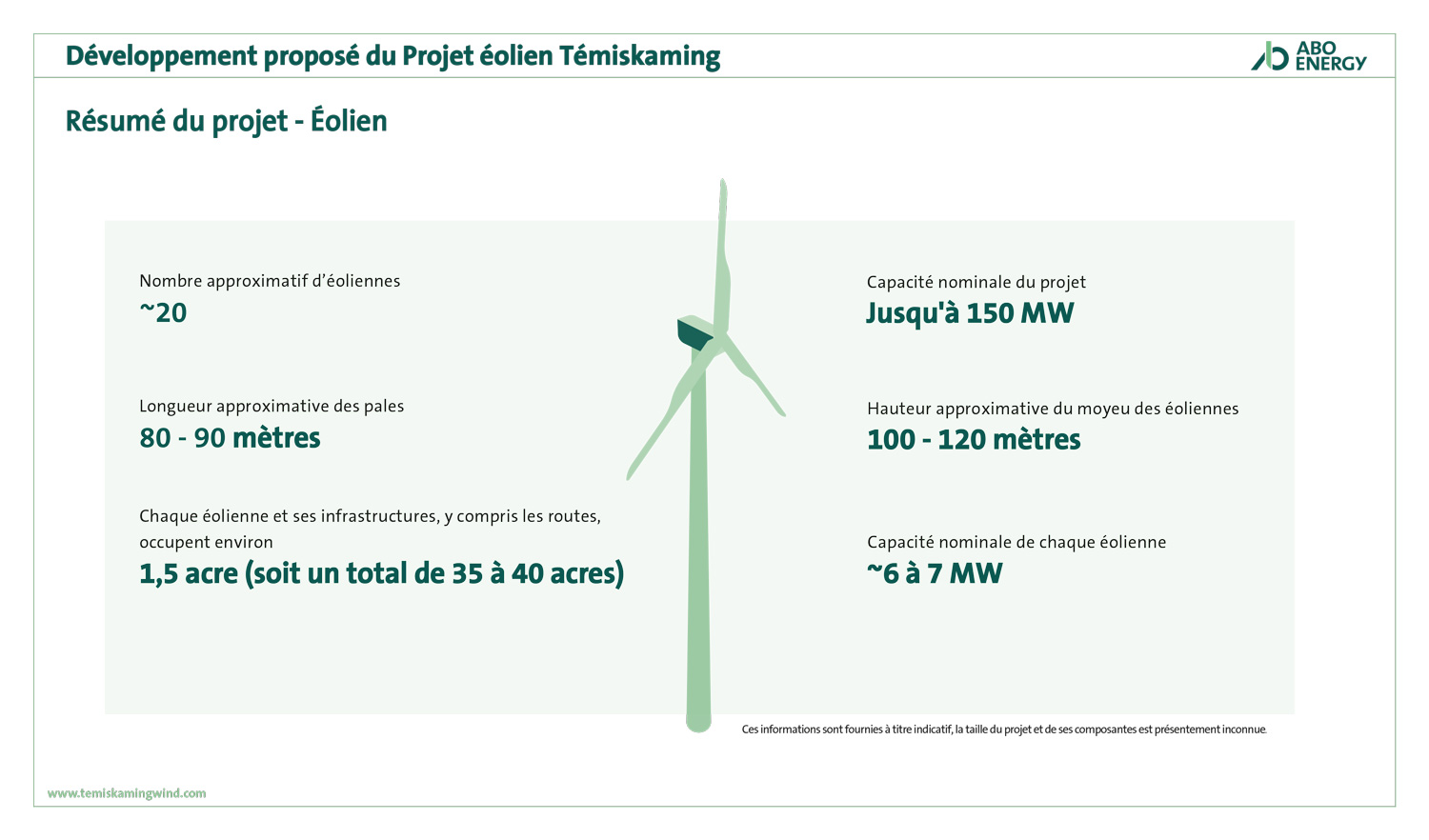

Développement proposé
Développement proposé
Project Map
Project Map
Project Map
Project Map

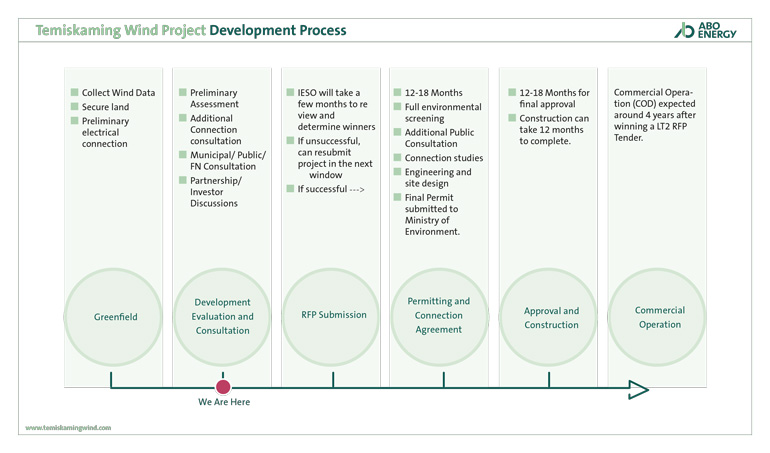

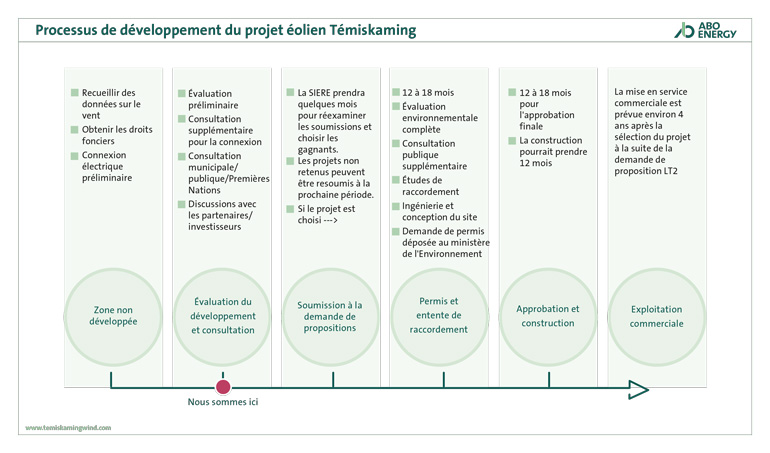

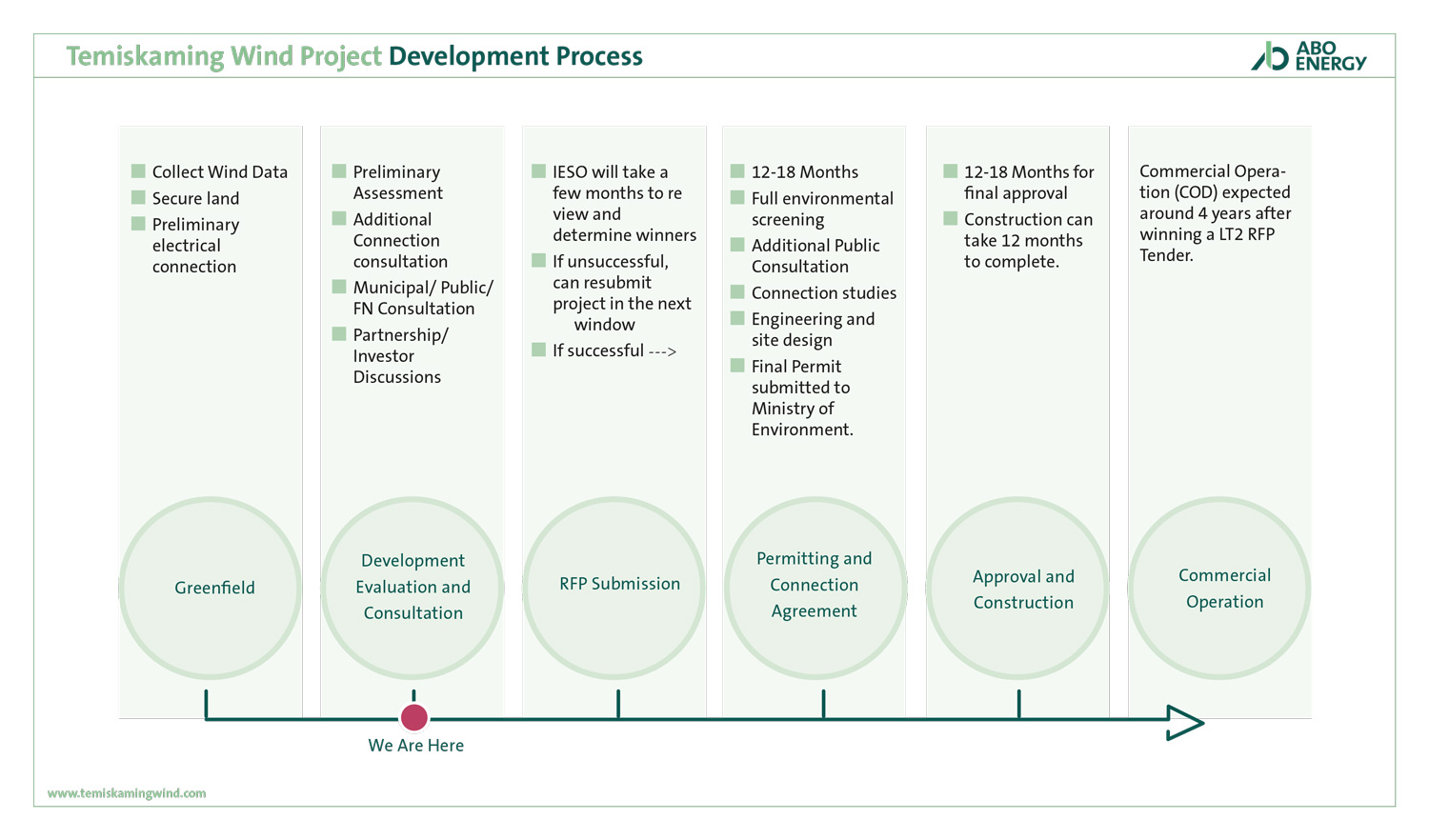

Development Process
Development Process

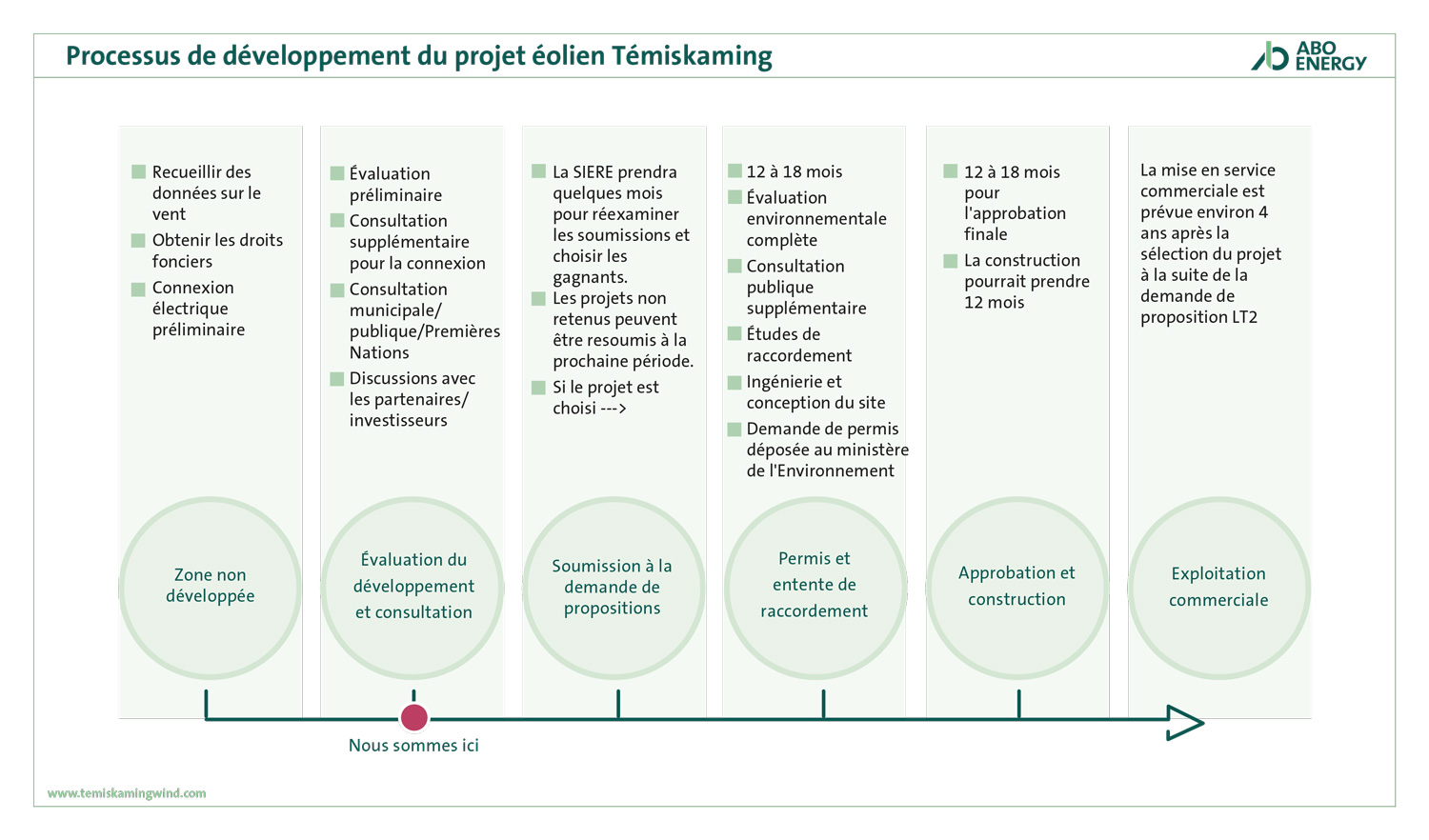

Processus de développement
Processus de développement
Project Schedule
Project Schedule
Échéancier du projet
Échéancier du projet

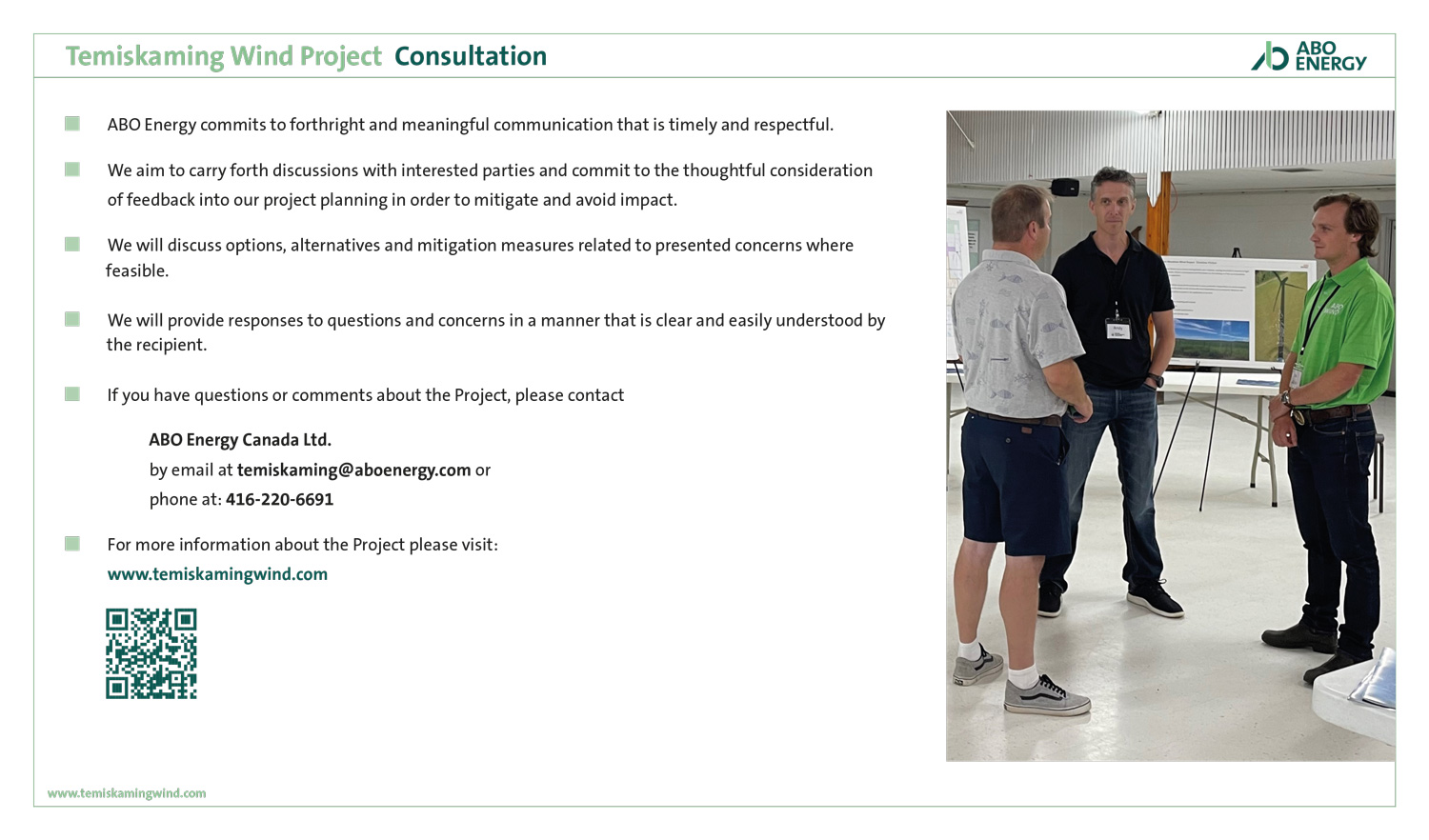

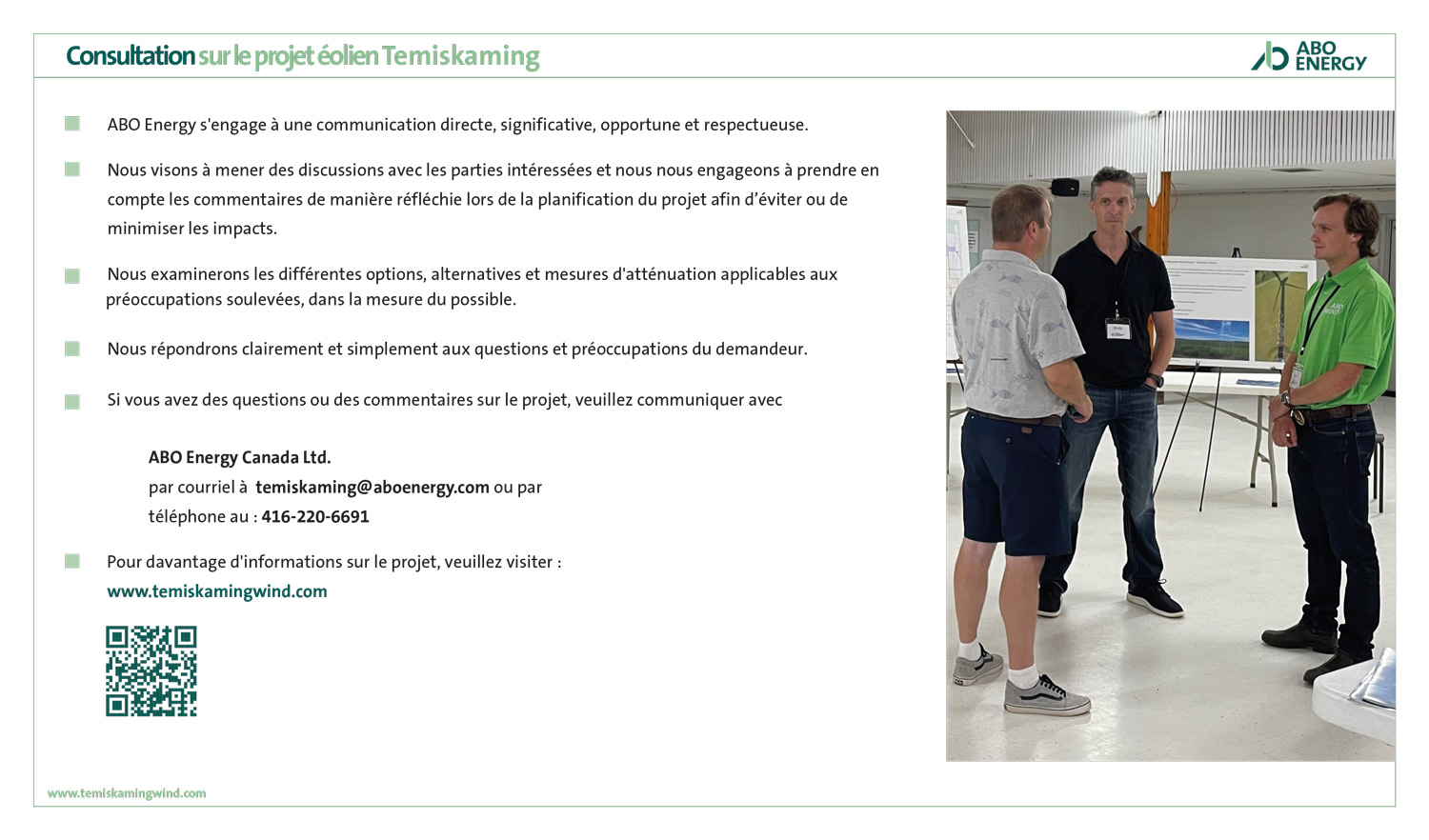

Consultation
Consultation
Consultation
Consultation

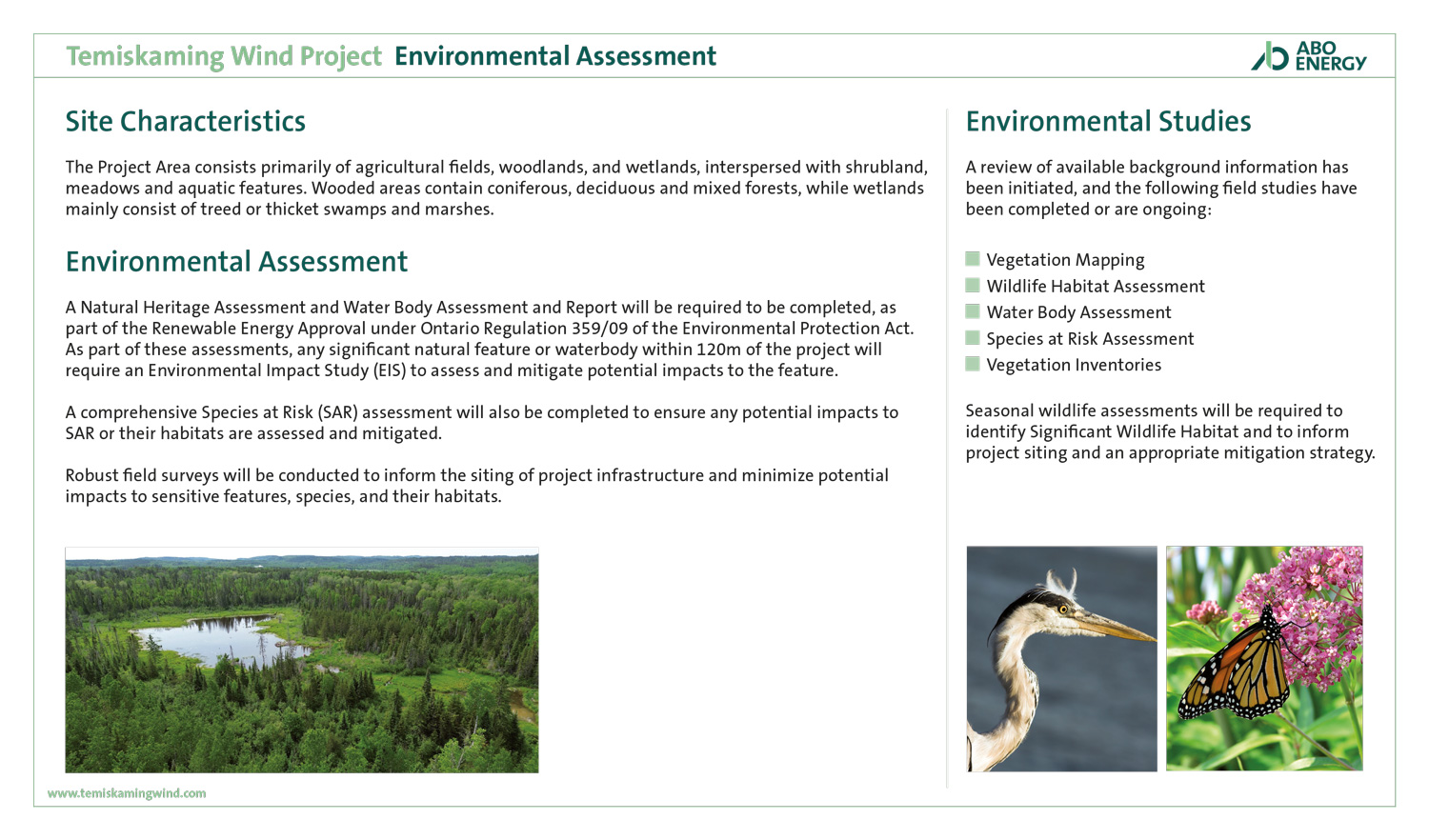

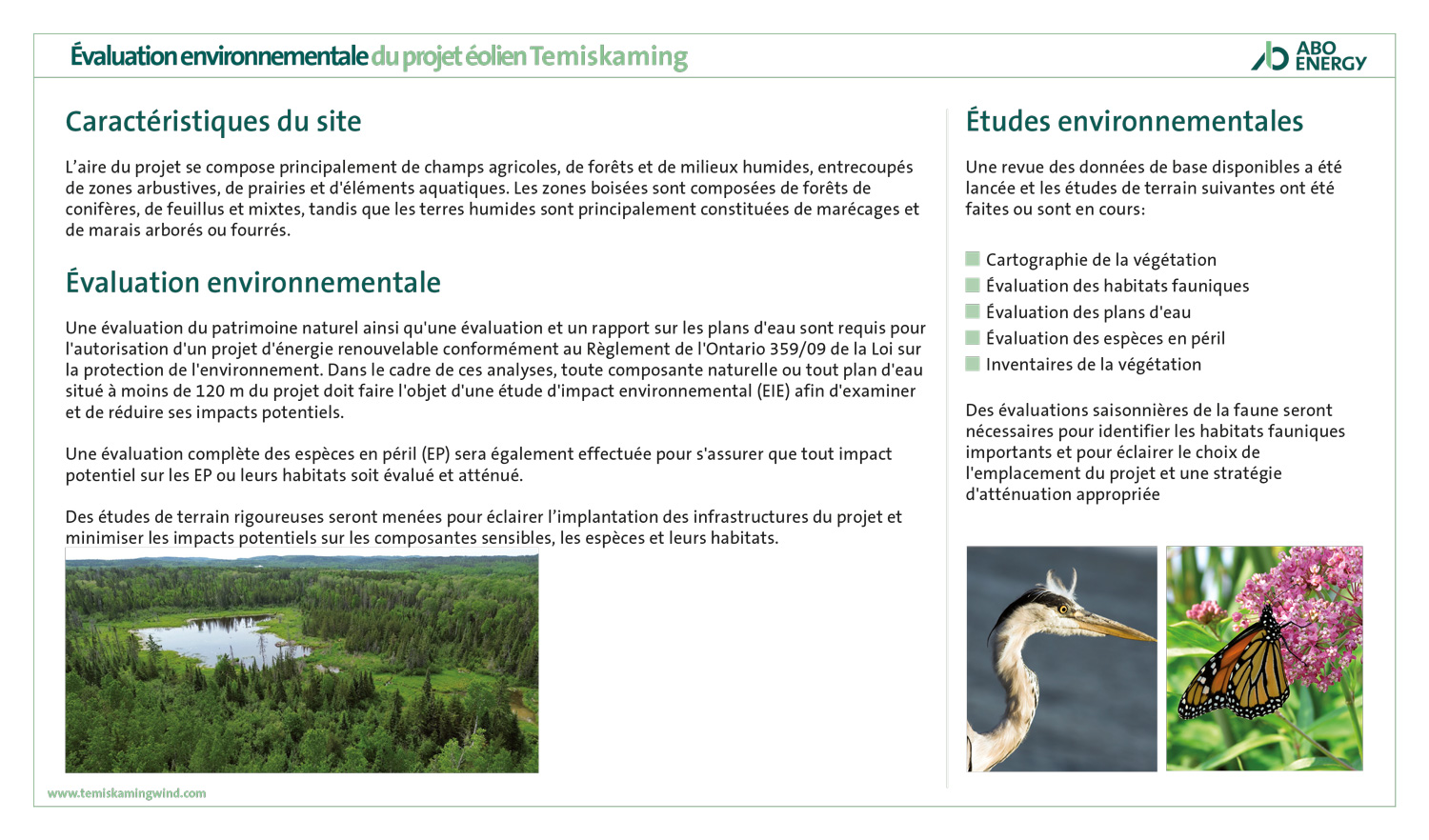

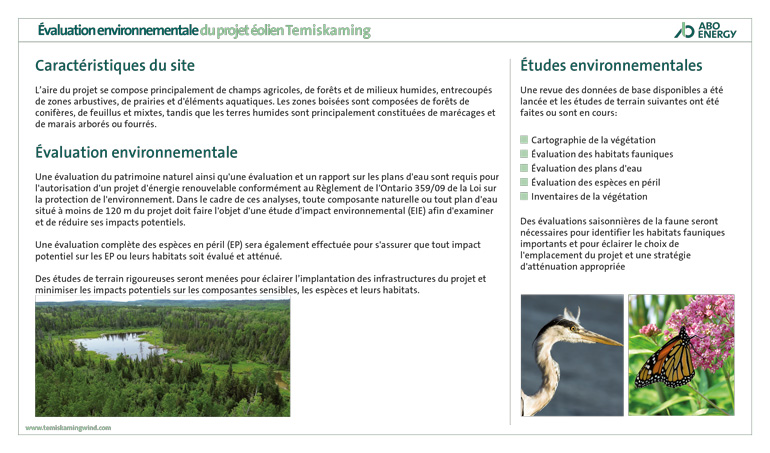

Environmental Assessment
Environmental Assessment
Évaluation environnementale
Évaluation environnementale

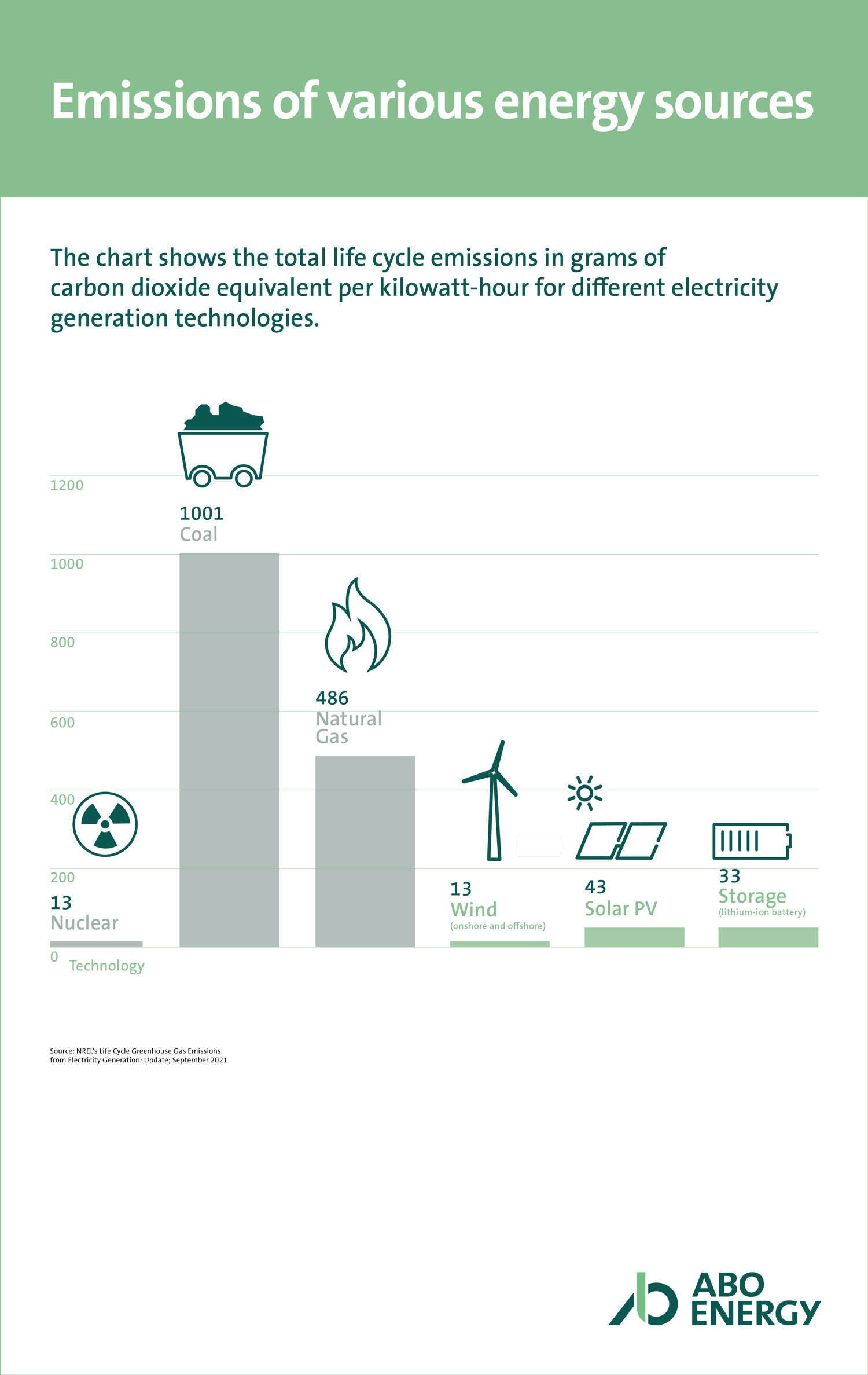

Emissions of Energy Sources
Emissions of Energy Sources
Émissions de sources d'énergie
Émissions de sources d'énergie

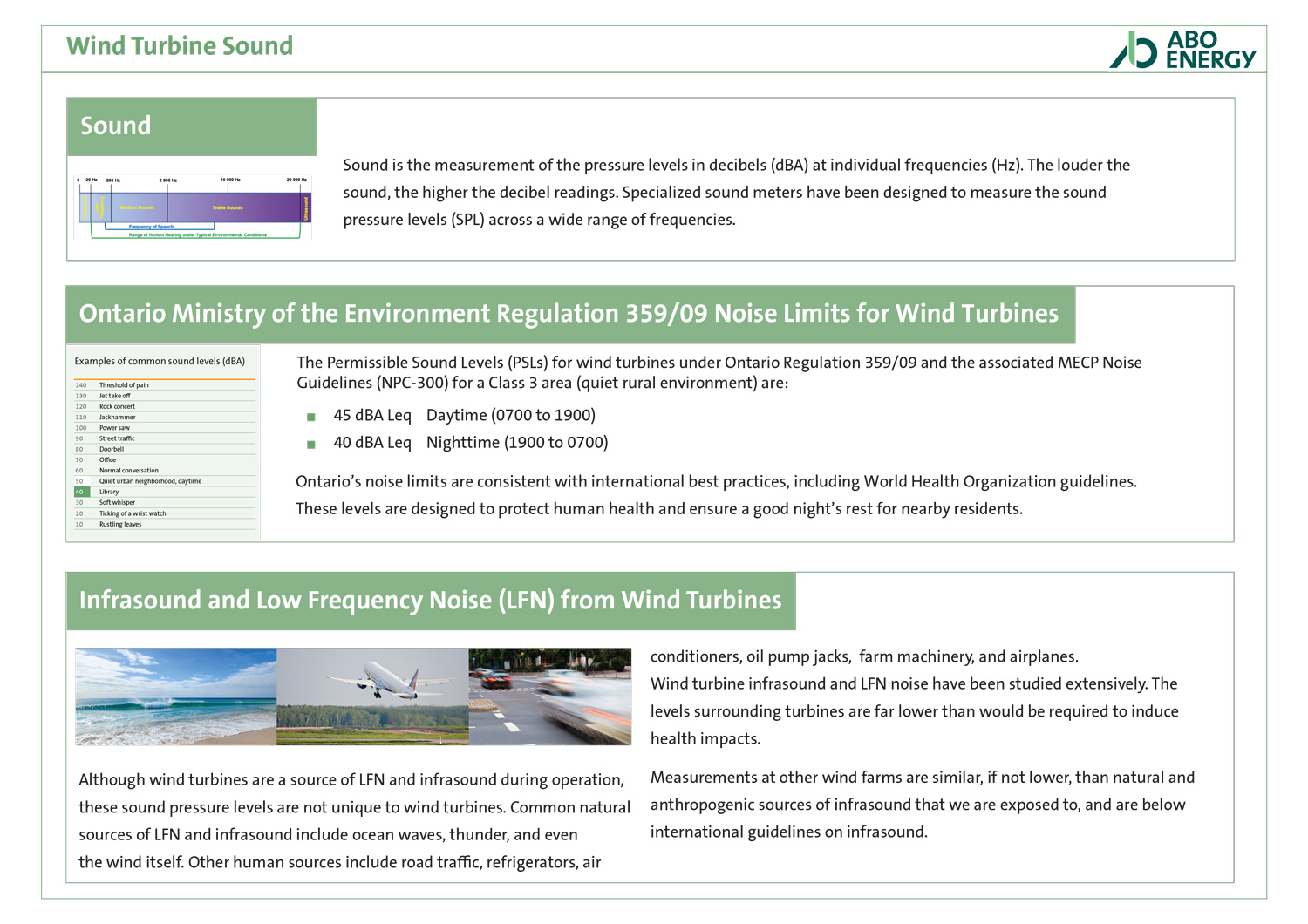

Wind Turbine Sound
Wind Turbine Sound

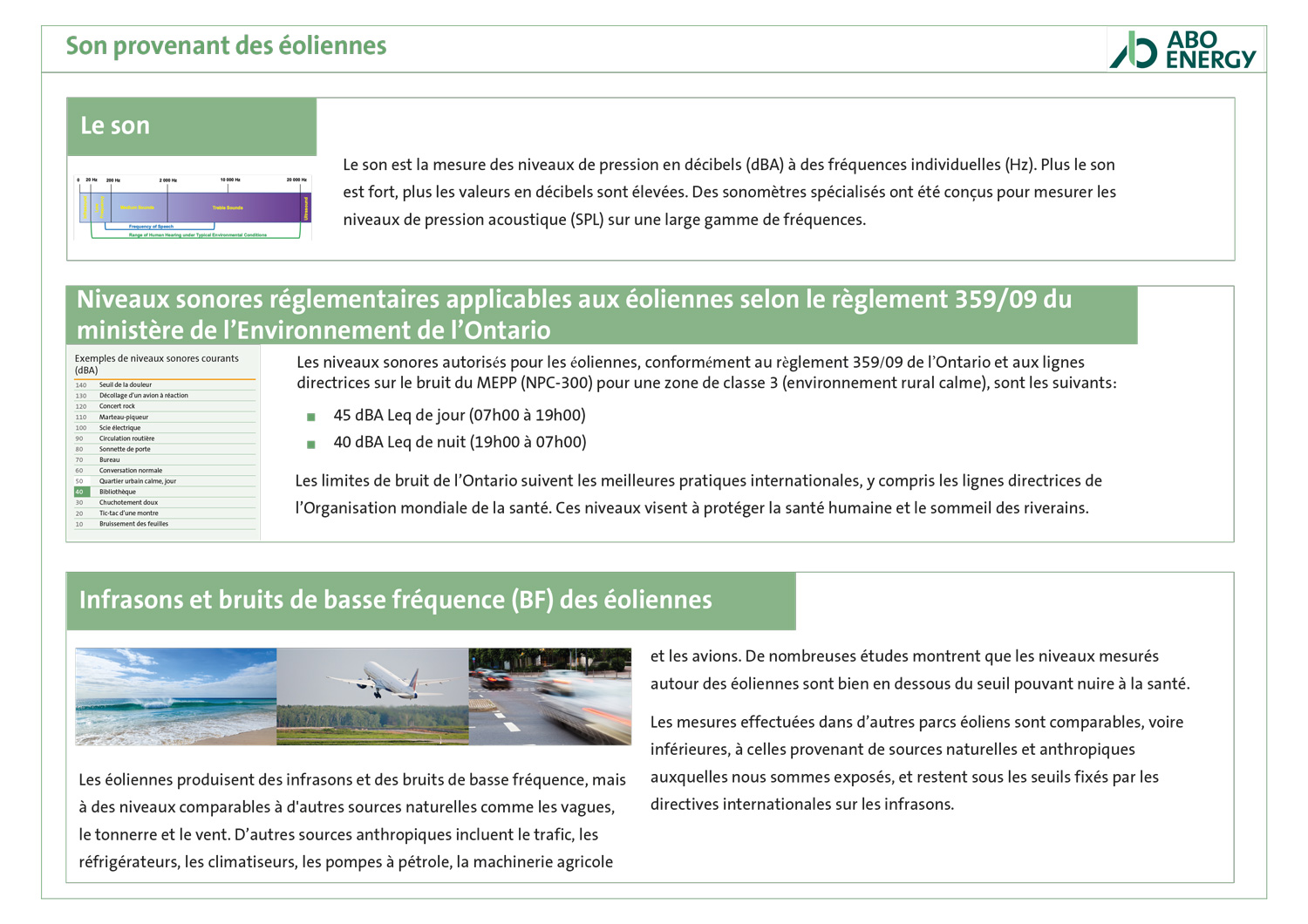

Son provenant des éoliennes
Son provenant des éoliennes
Shadow Flicker
Shadow Flicker
Battement d'ombre
Battement d'ombre

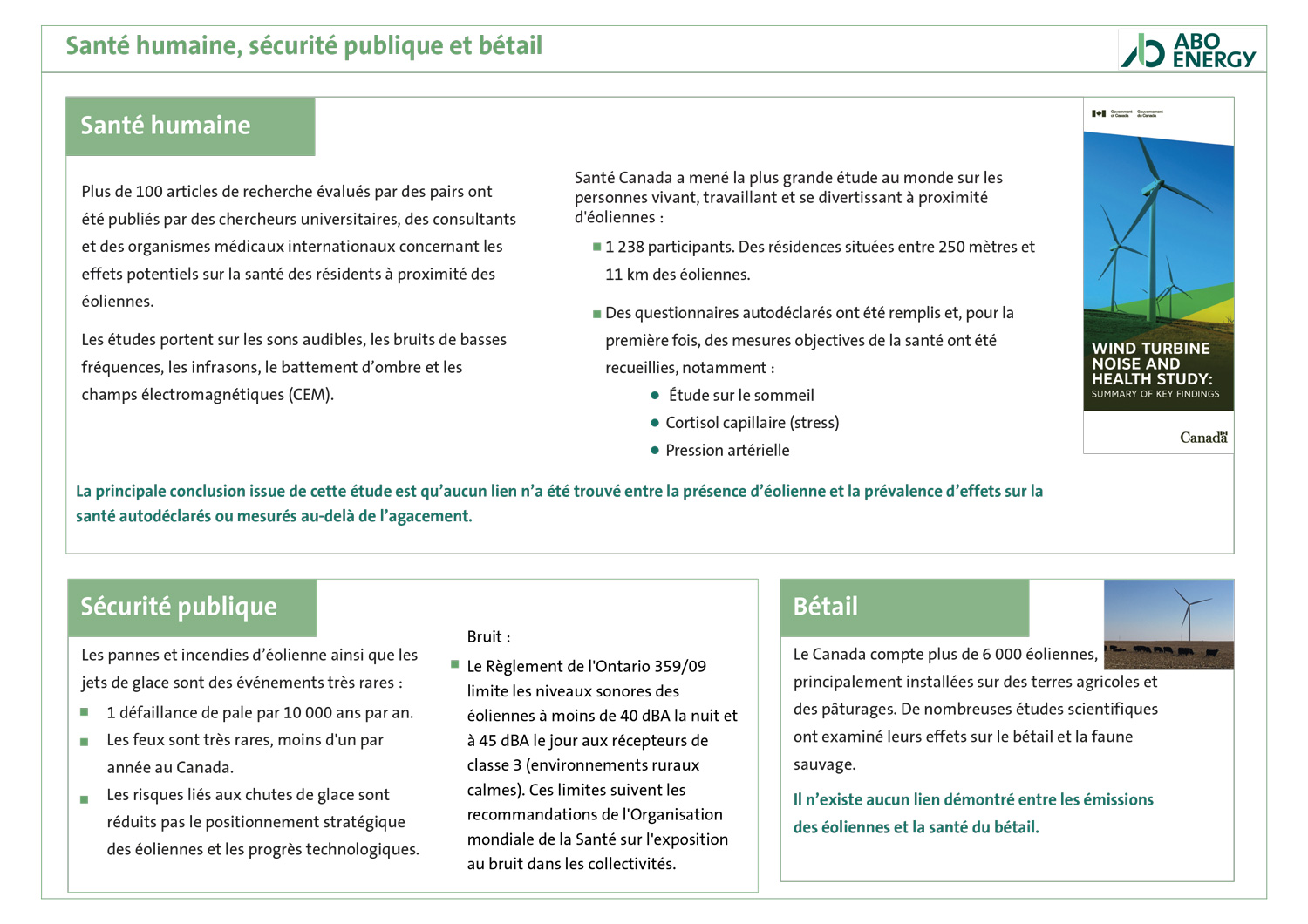

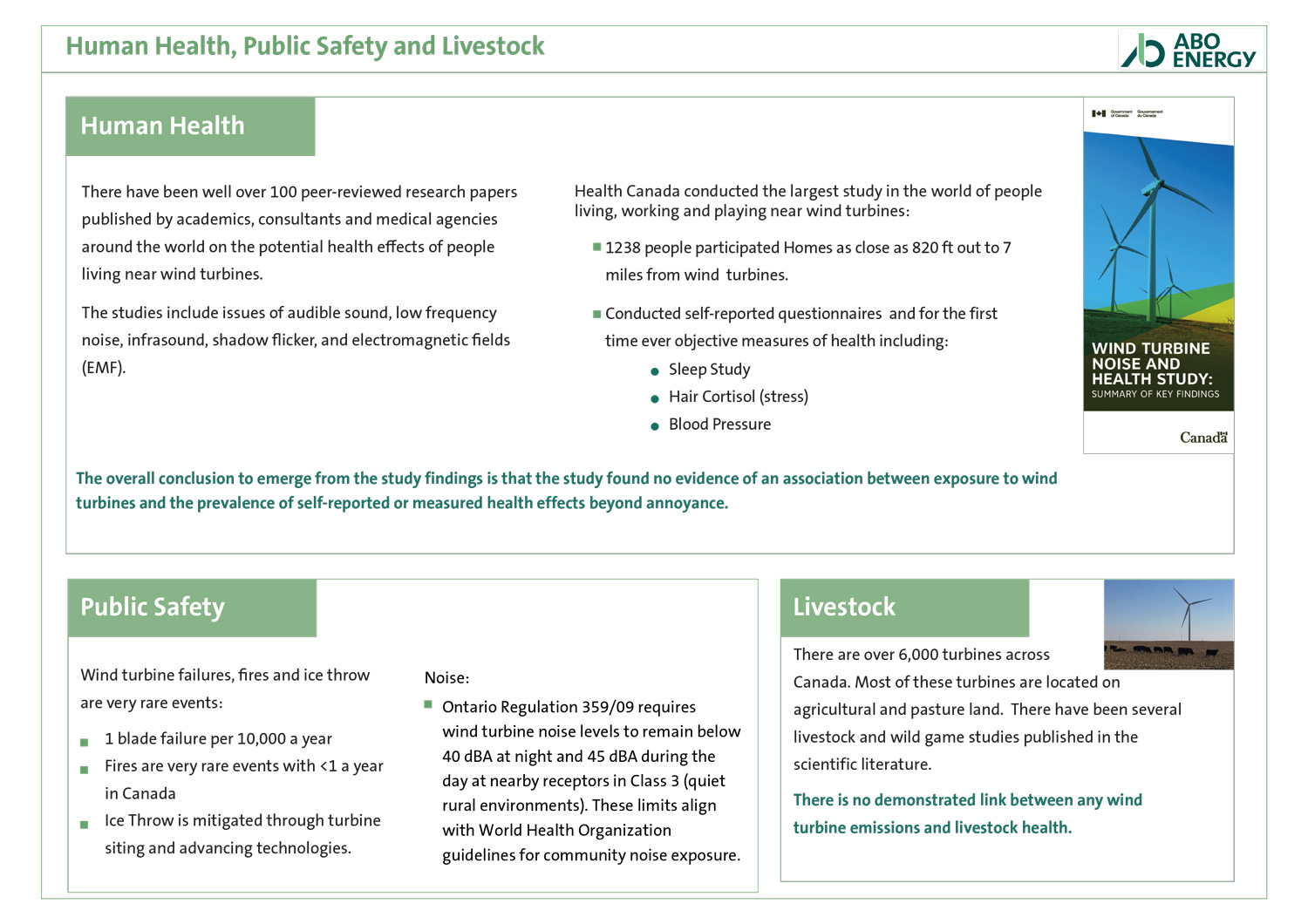

Human Health, Public Safety and Livestock
Human Health, Public Safety and Livestock
Santé humaine, sécurité publique et bétail
Santé humaine, sécurité publique et bétail

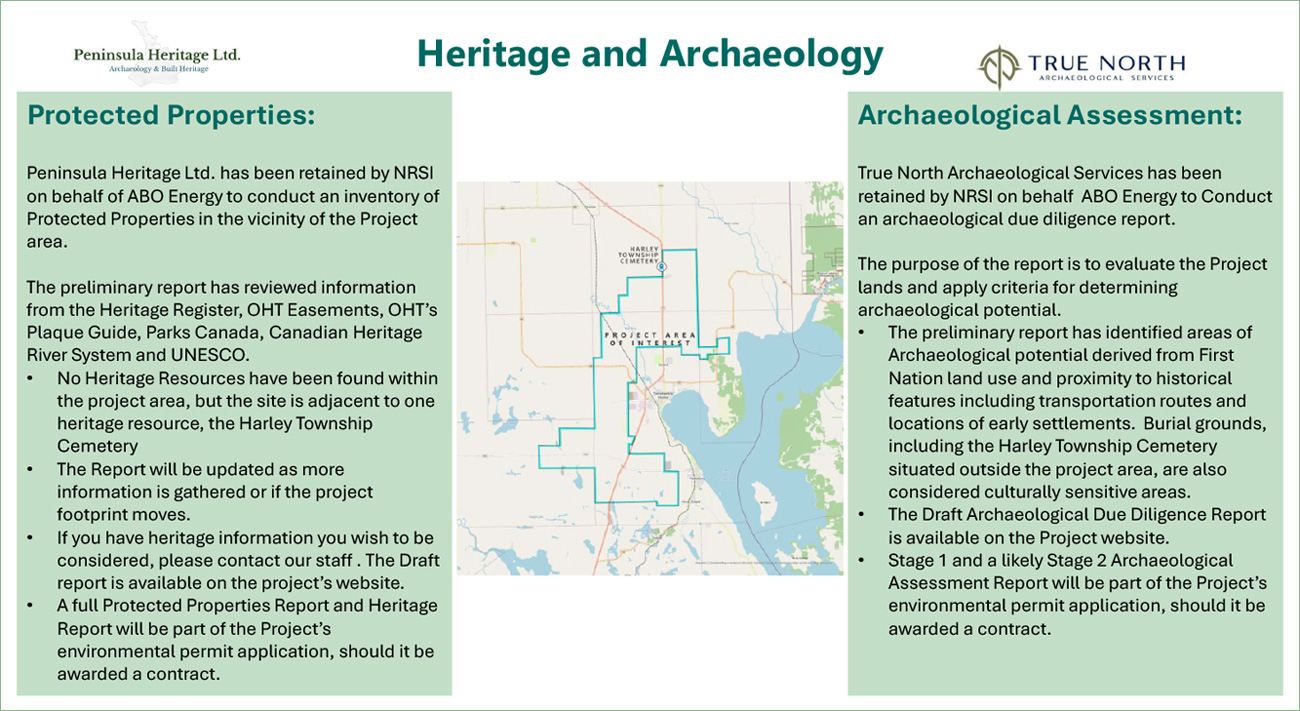

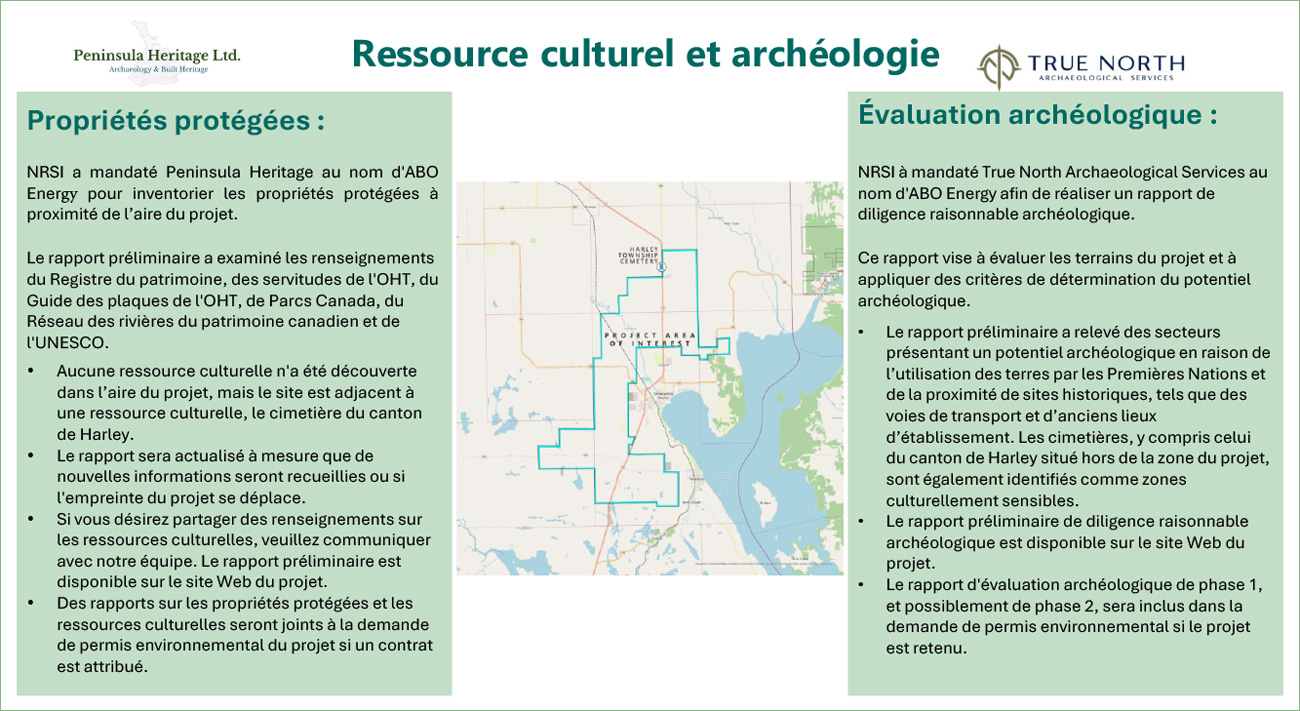

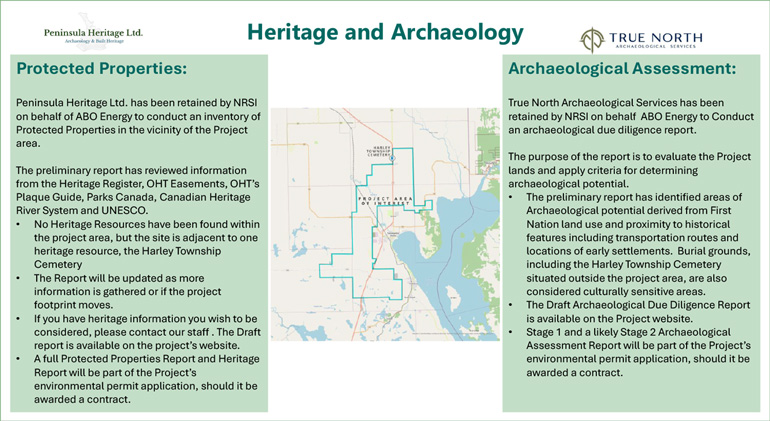

Heritage and Archaeology
Heritage and Archaeology
Ressource culturel et archéologie
Ressource culturel et archéologie

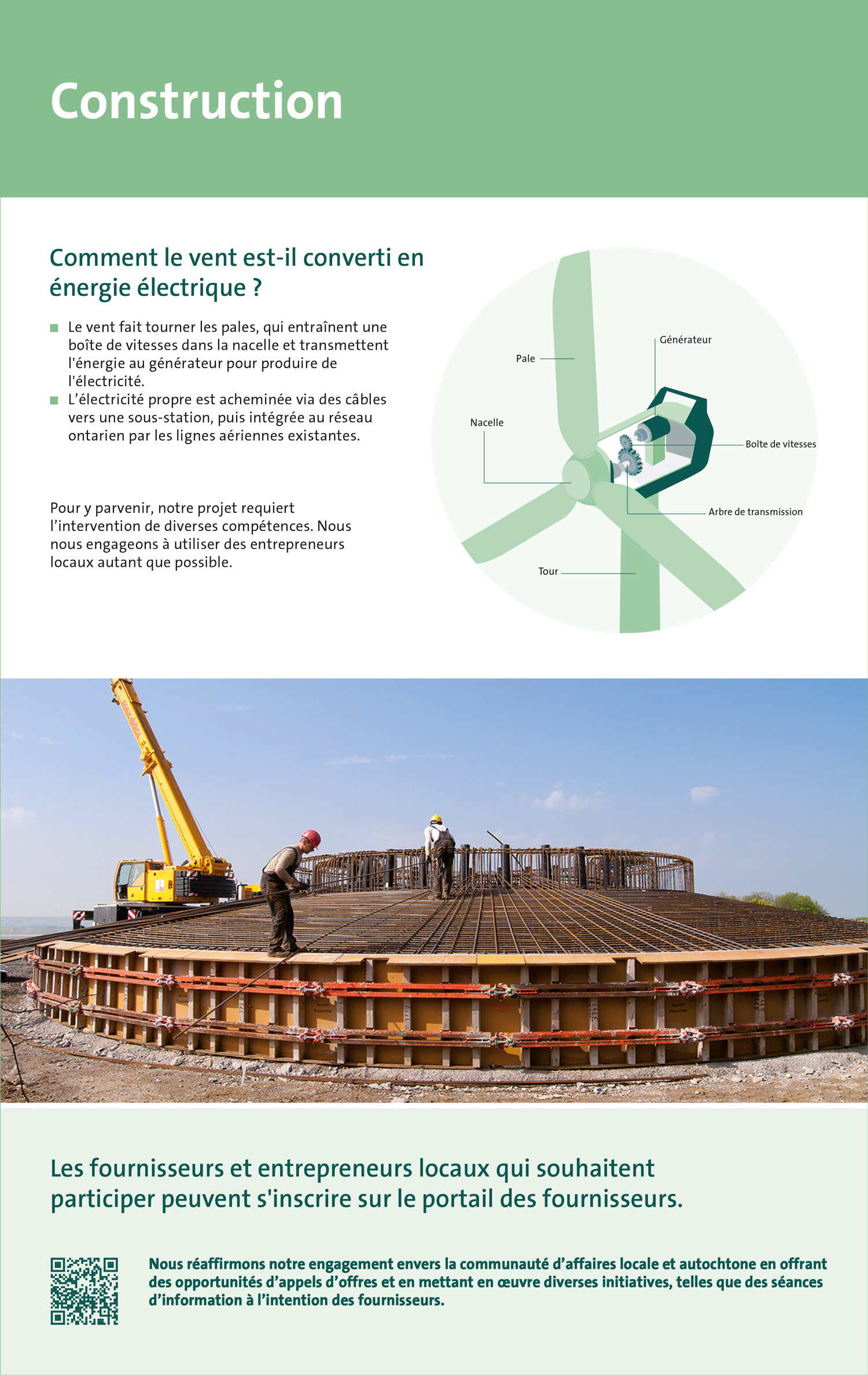

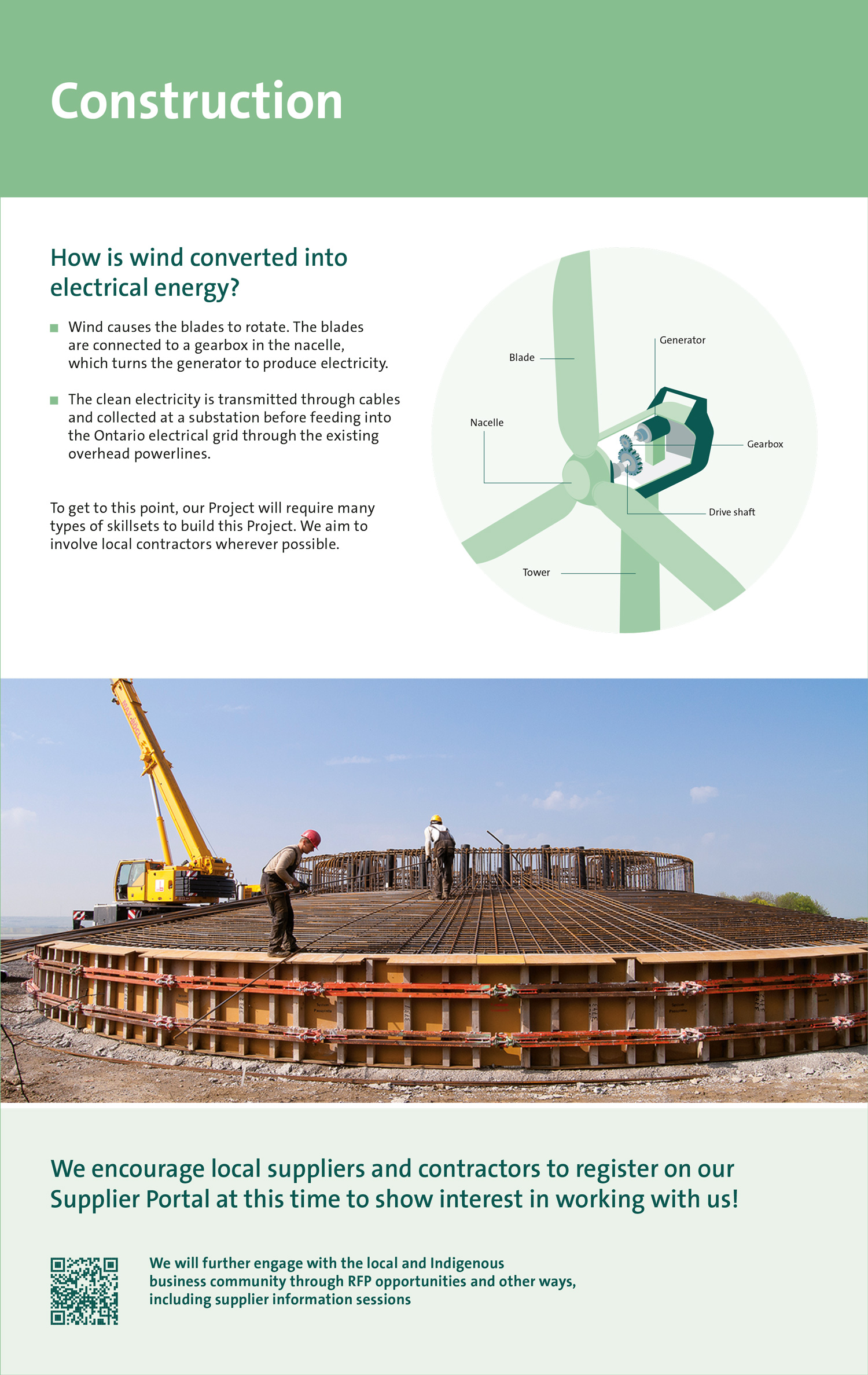

How is wind converted into electrical energy?
How is wind converted into electrical energy?
Comment le vent est-il converti en énergie électrique ?
Comment le vent est-il converti en énergie électrique ?

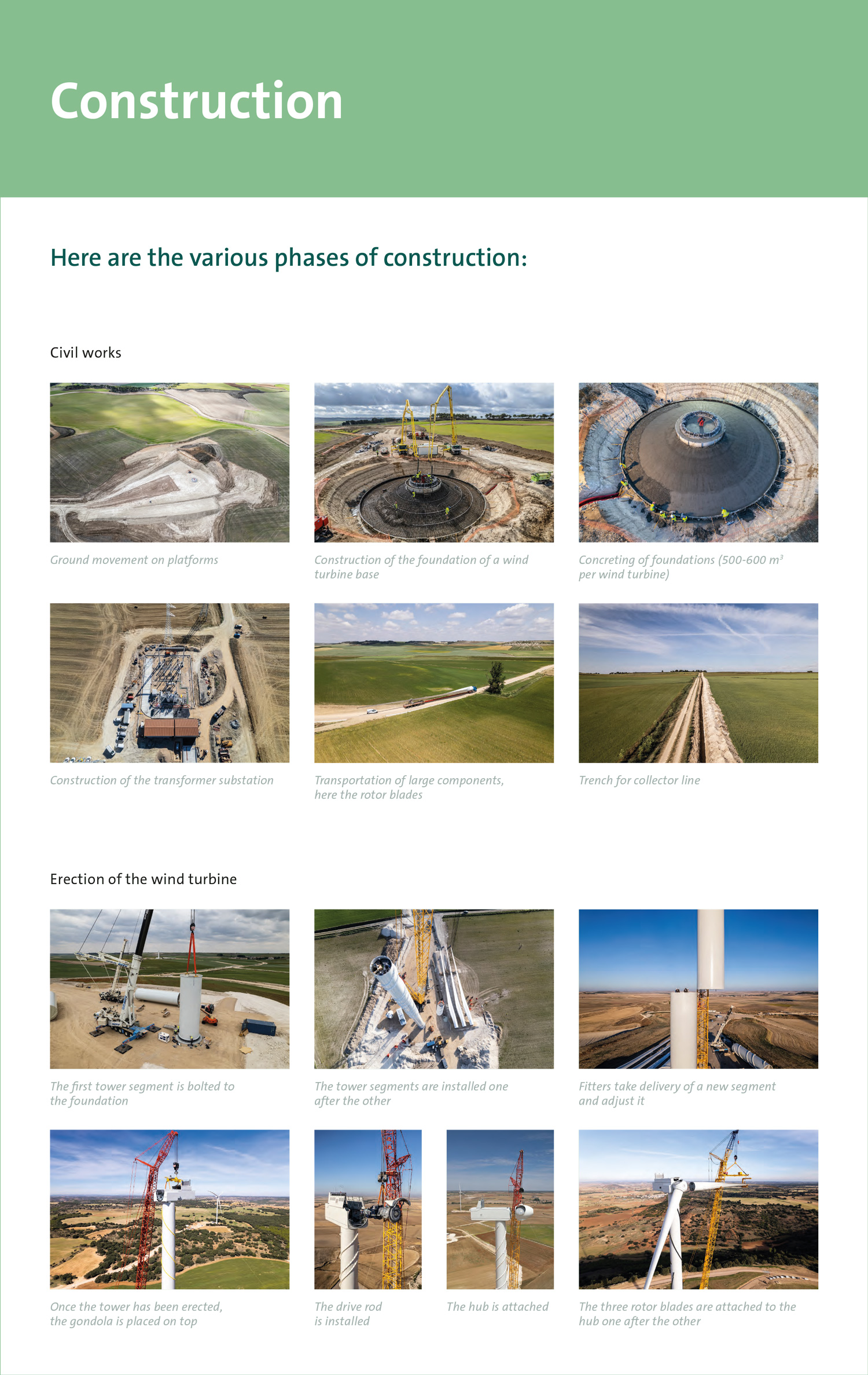

Construction Phases
Construction Phases
Étapes de construction
Étapes de construction

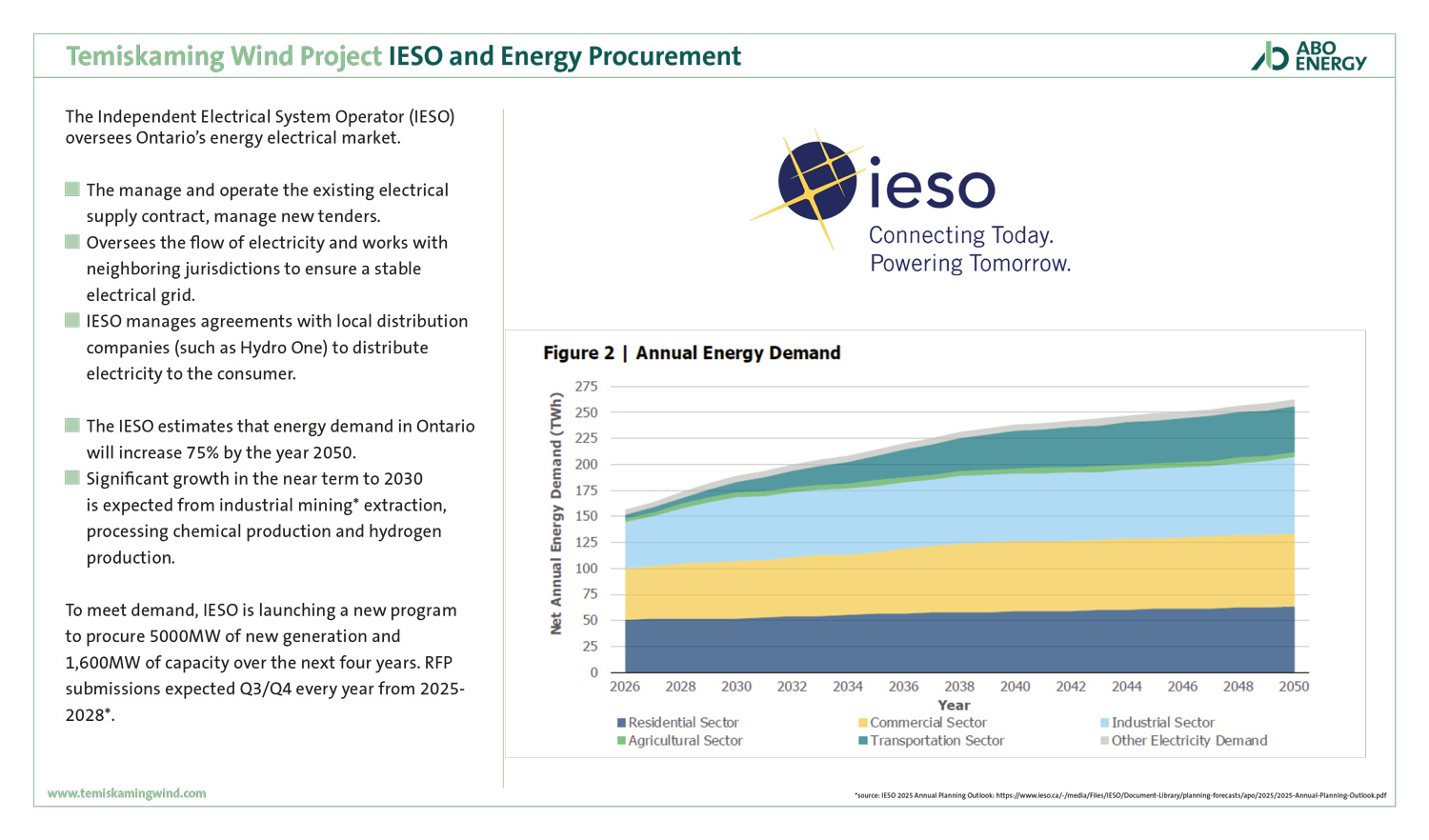

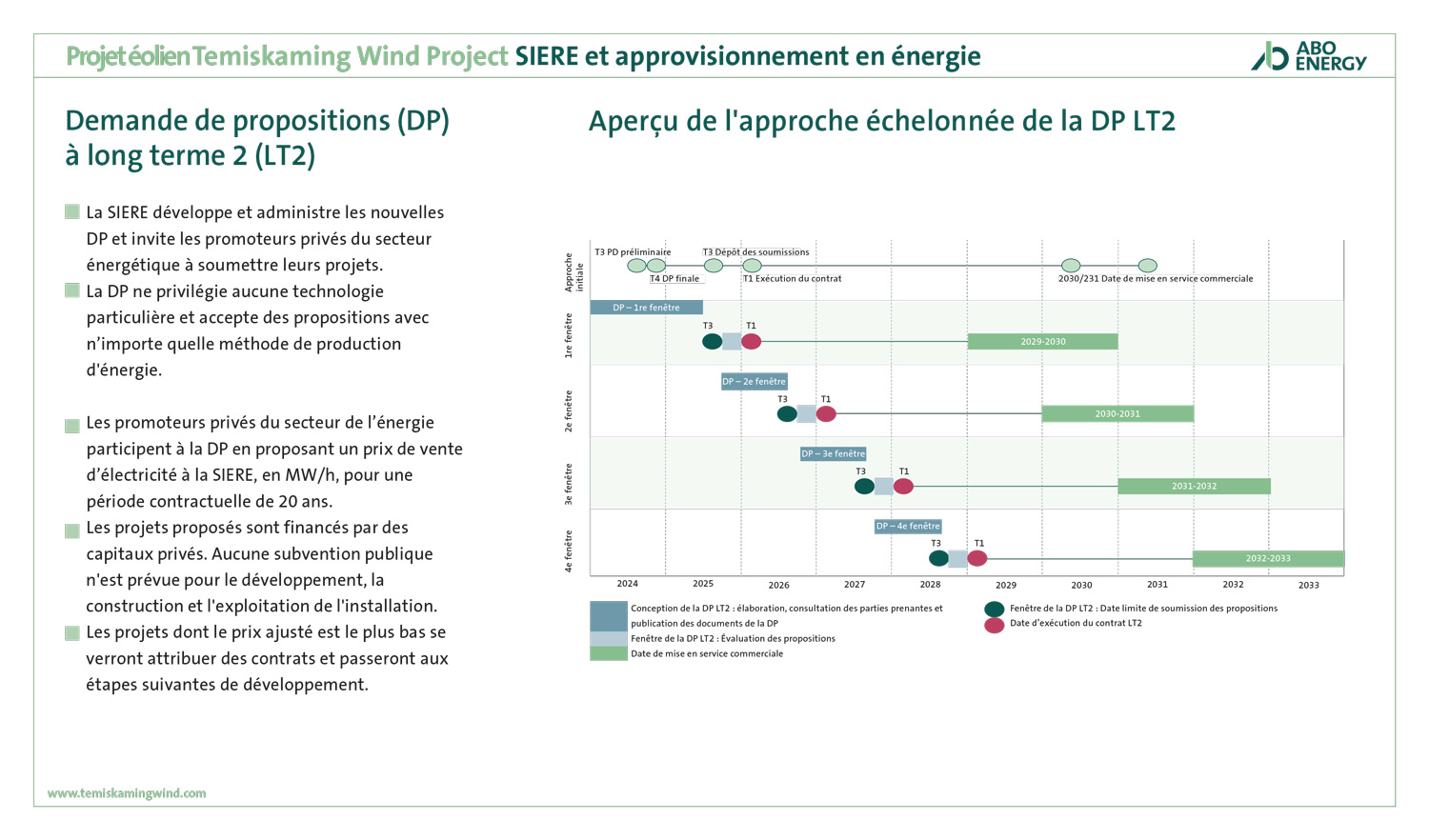

IESO and Energy Procurement 1
IESO and Energy Procurement 1
SIERE et approvisionnement en énergie 1
SIERE et approvisionnement en énergie

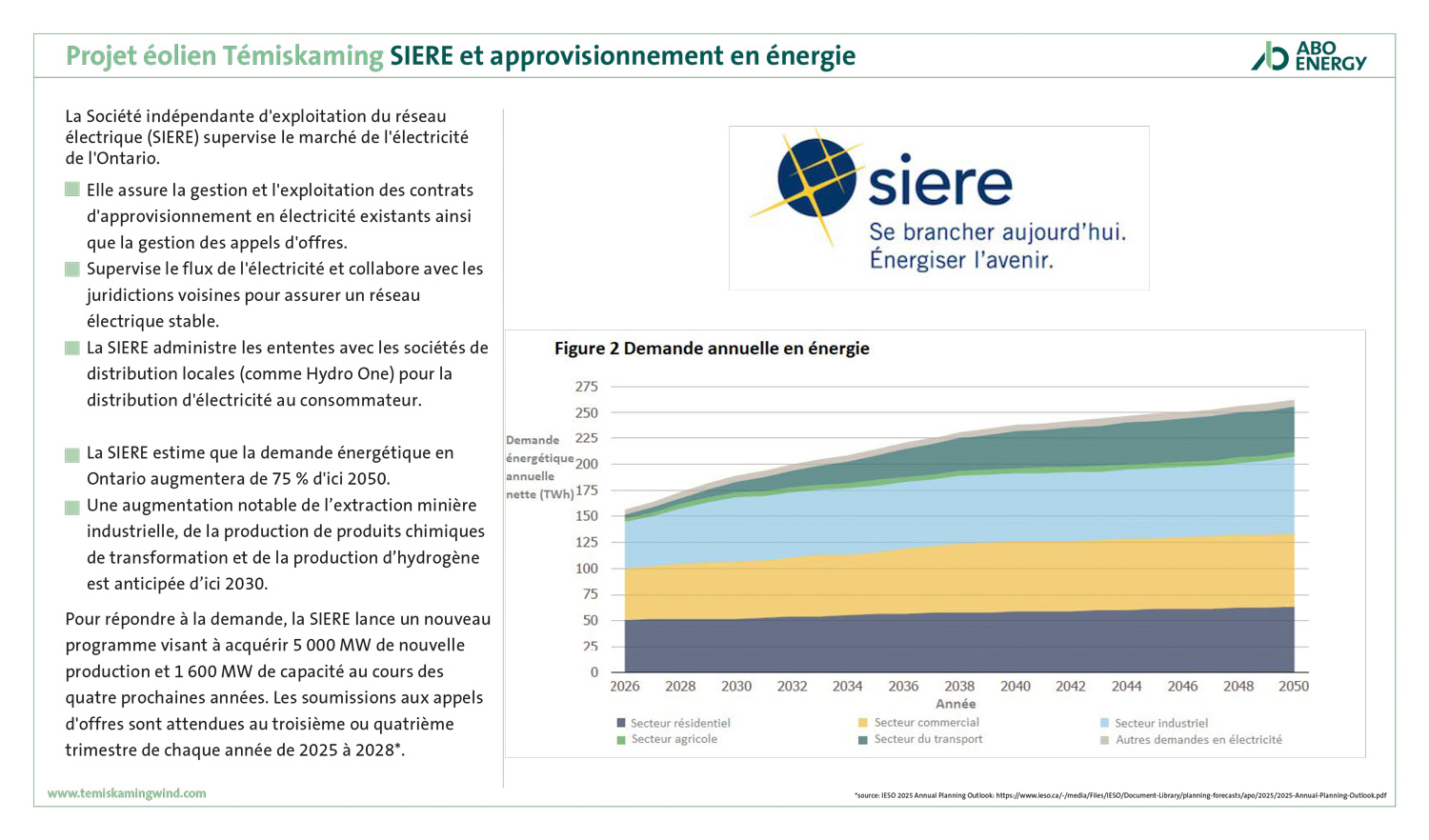

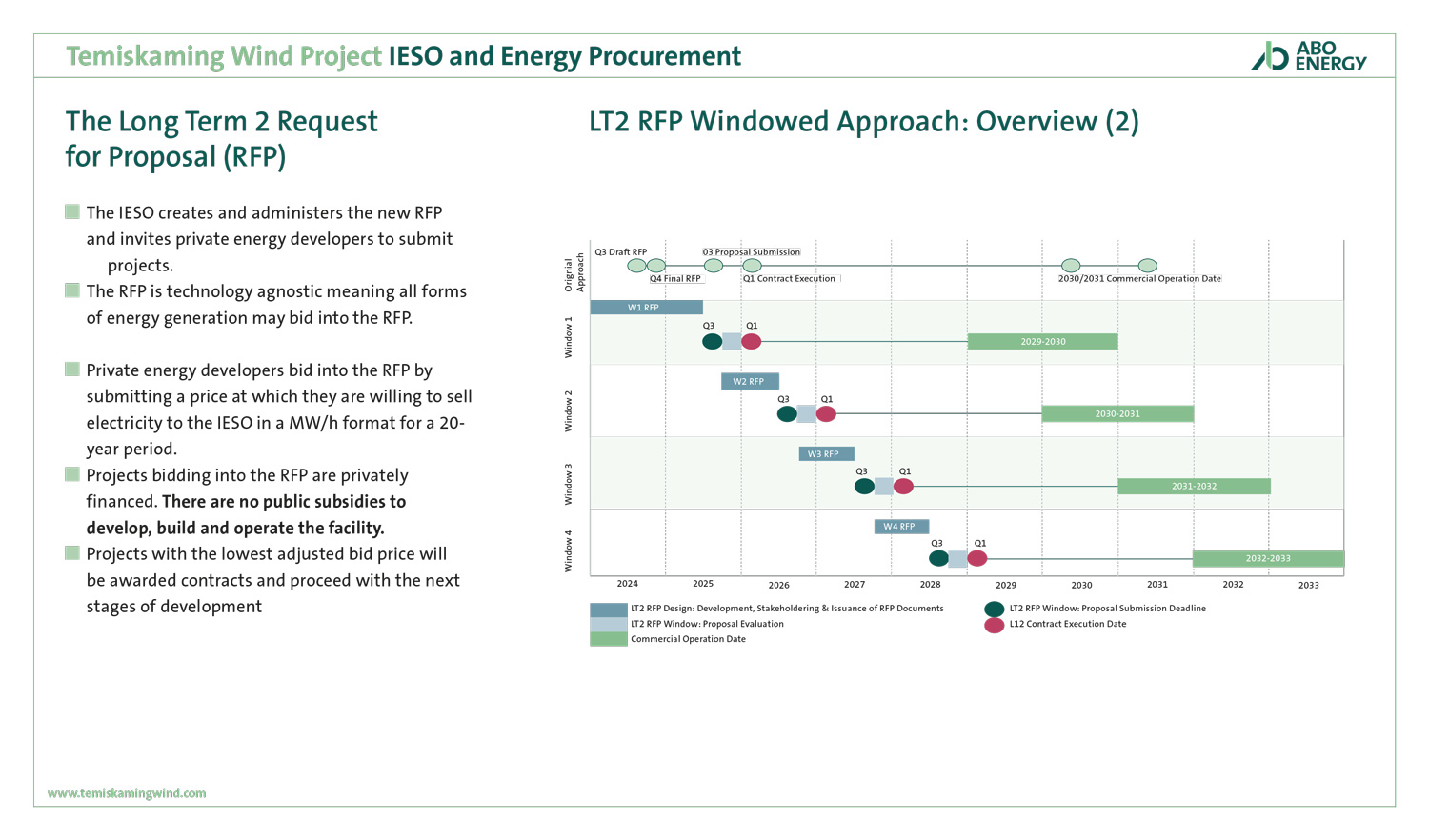

IESO and Energy Procurement 2
IESO and Energy Procurement 2
SIERE et approvisionnement en énergie 2
SIERE et approvisionnement en énergie

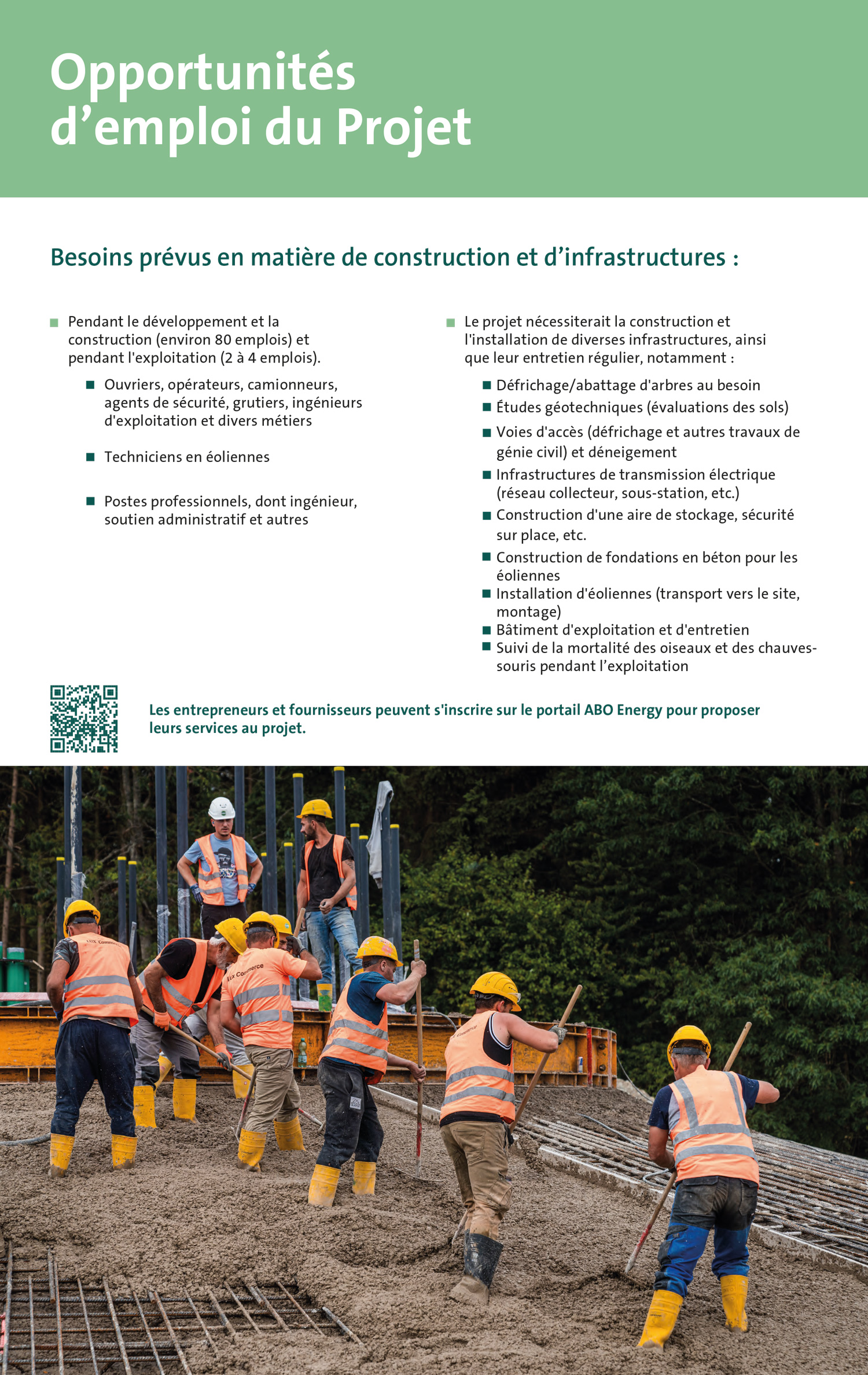

Project Employment Opportunities
Project Employment Opportunities
Opportunités d’emploi du Projet
Opportunités d’emploi du Projet

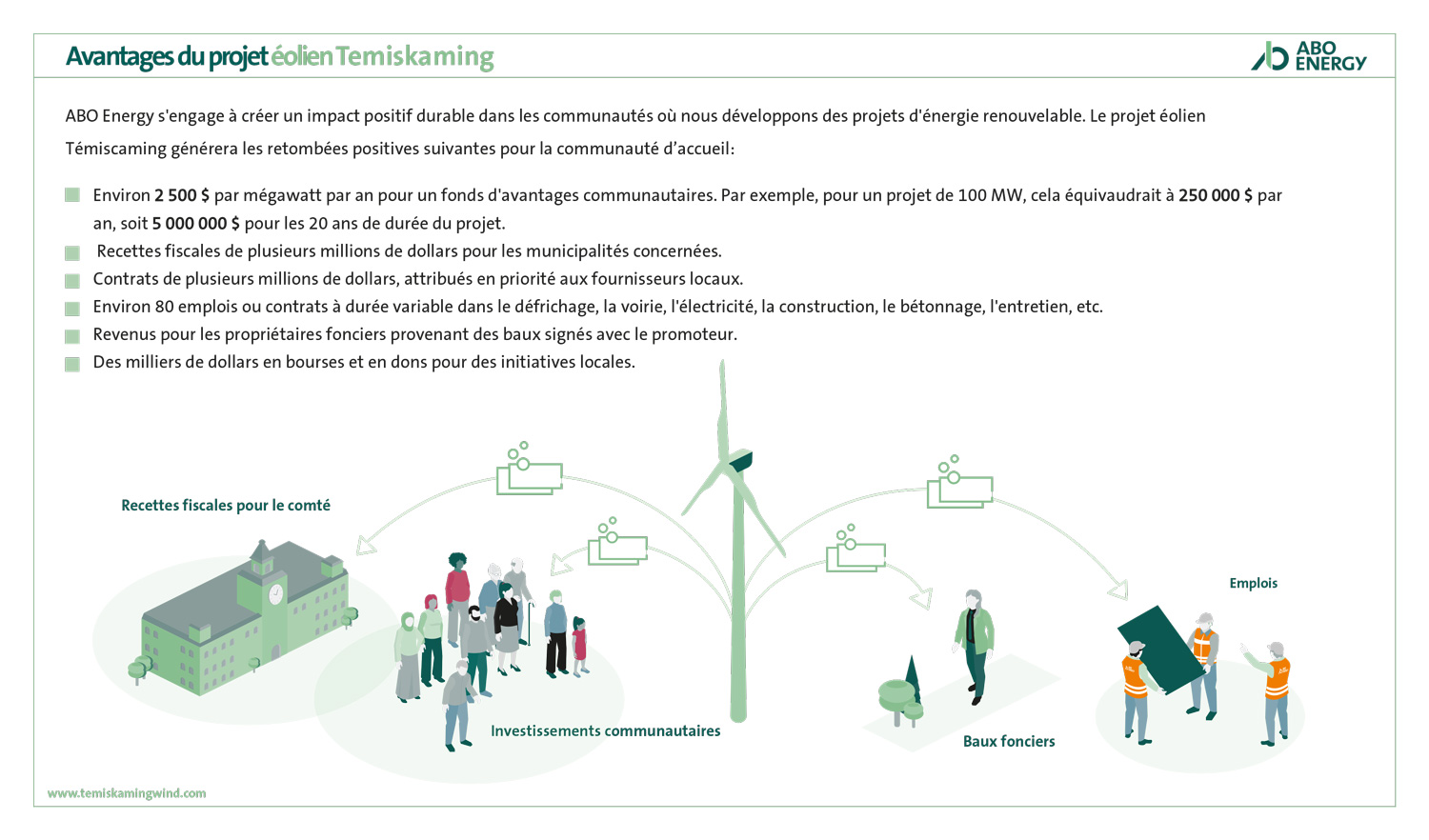

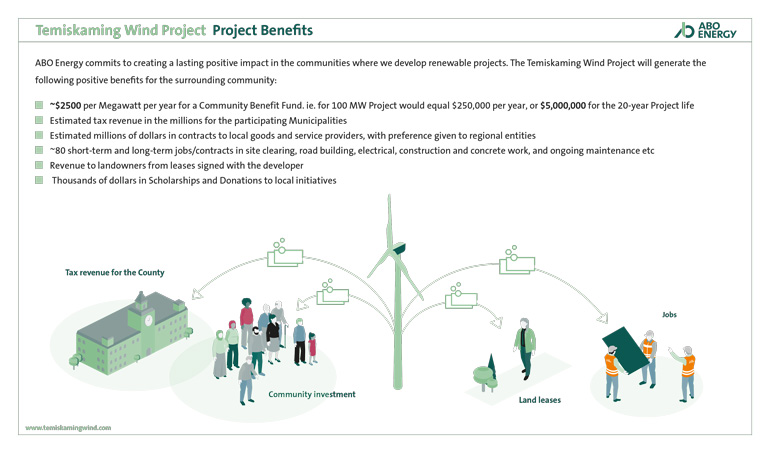

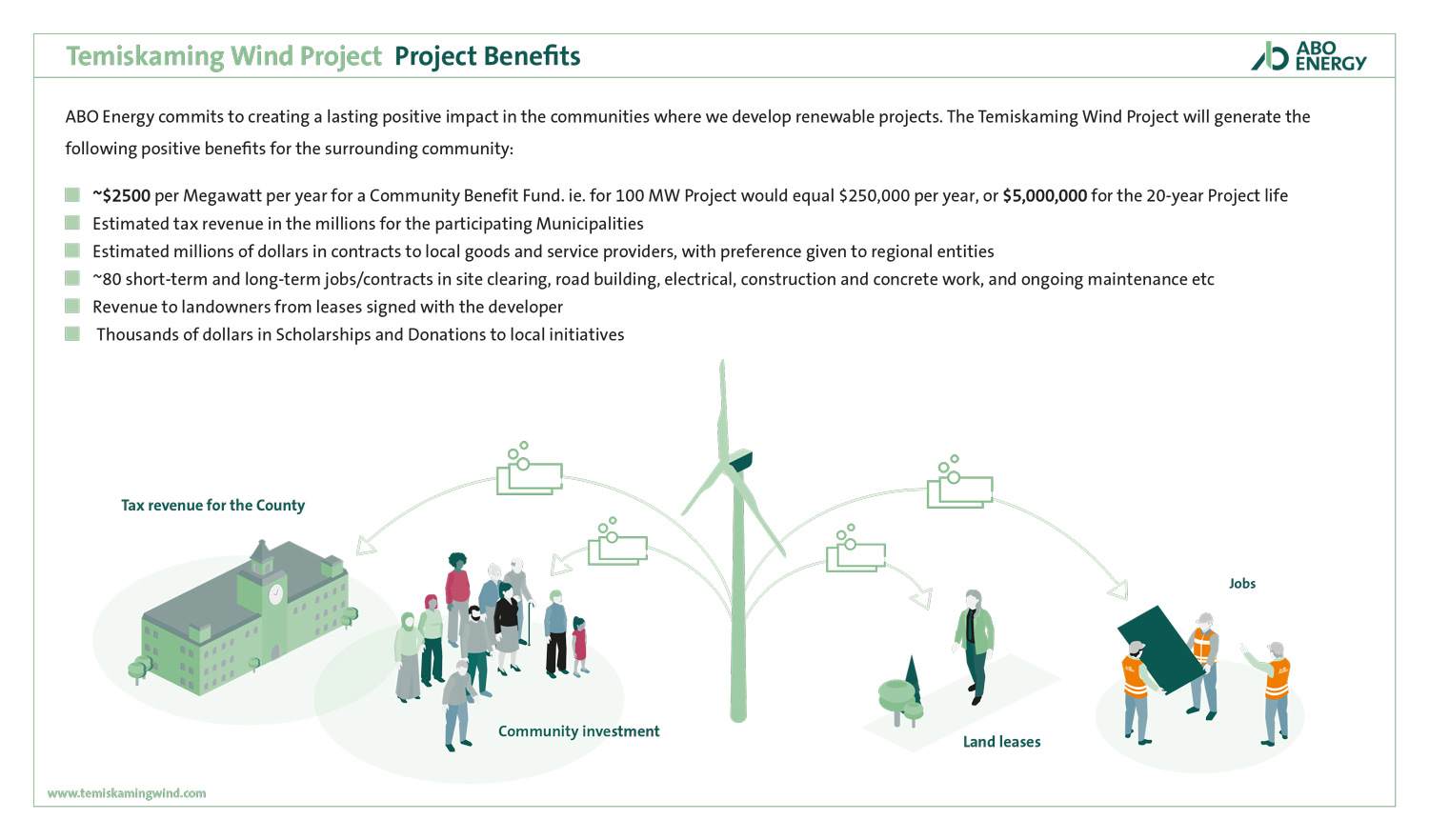

Project Benefits
Project Benefits
Avantages du projet
Avantages du projet

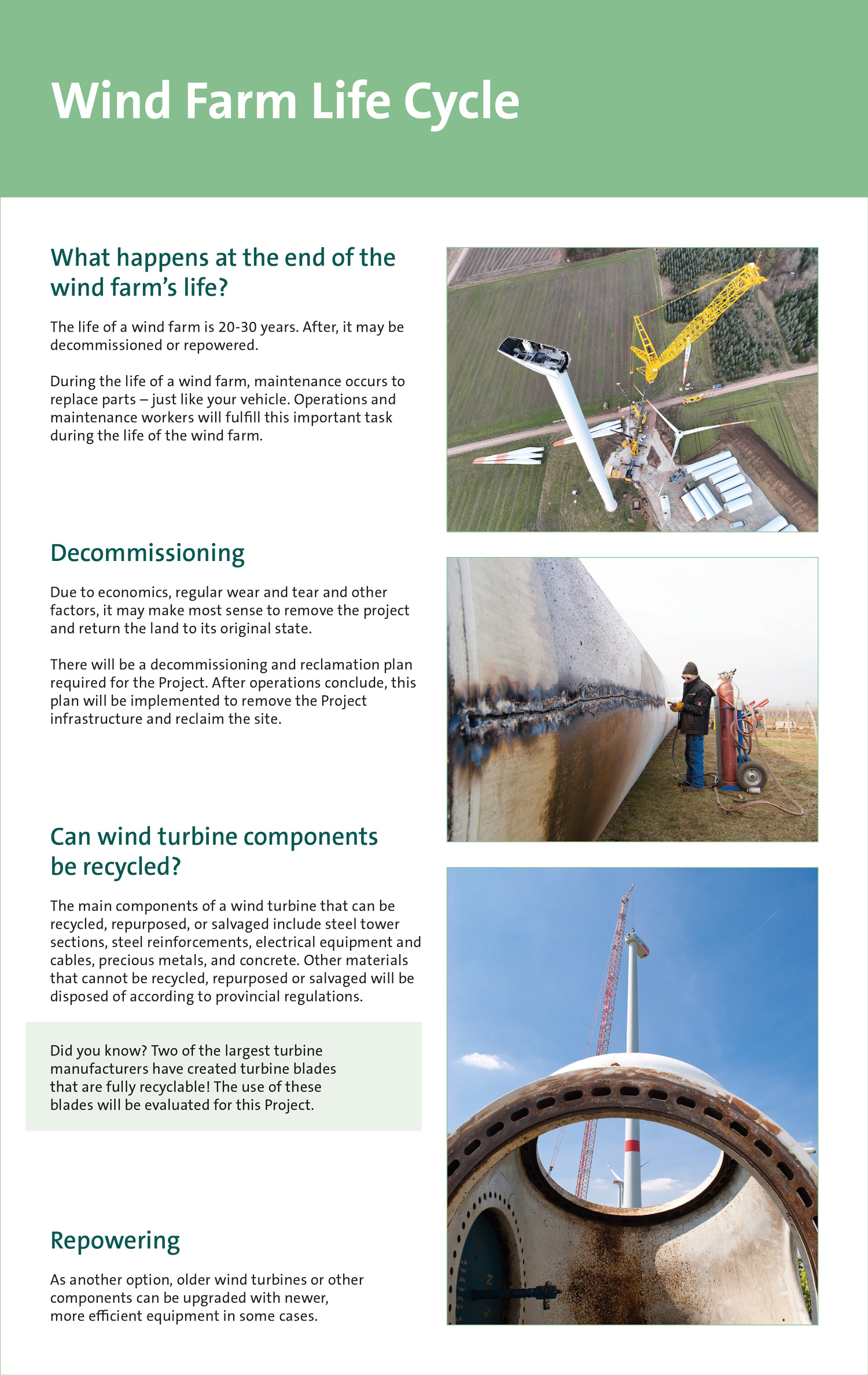

Wind Farm Life Cycle
Wind Farm Life Cycle
Cycle de vie d'un parc éolien
Cycle de vie d'un parc éolien

Project information

Project Location

The Project will be situated within the District of Timiskaming, primarily west of New Liskeard and largely within the Municipal boundaries of Temiskaming Shores. The site comprises private lands under option agreements with landowners.

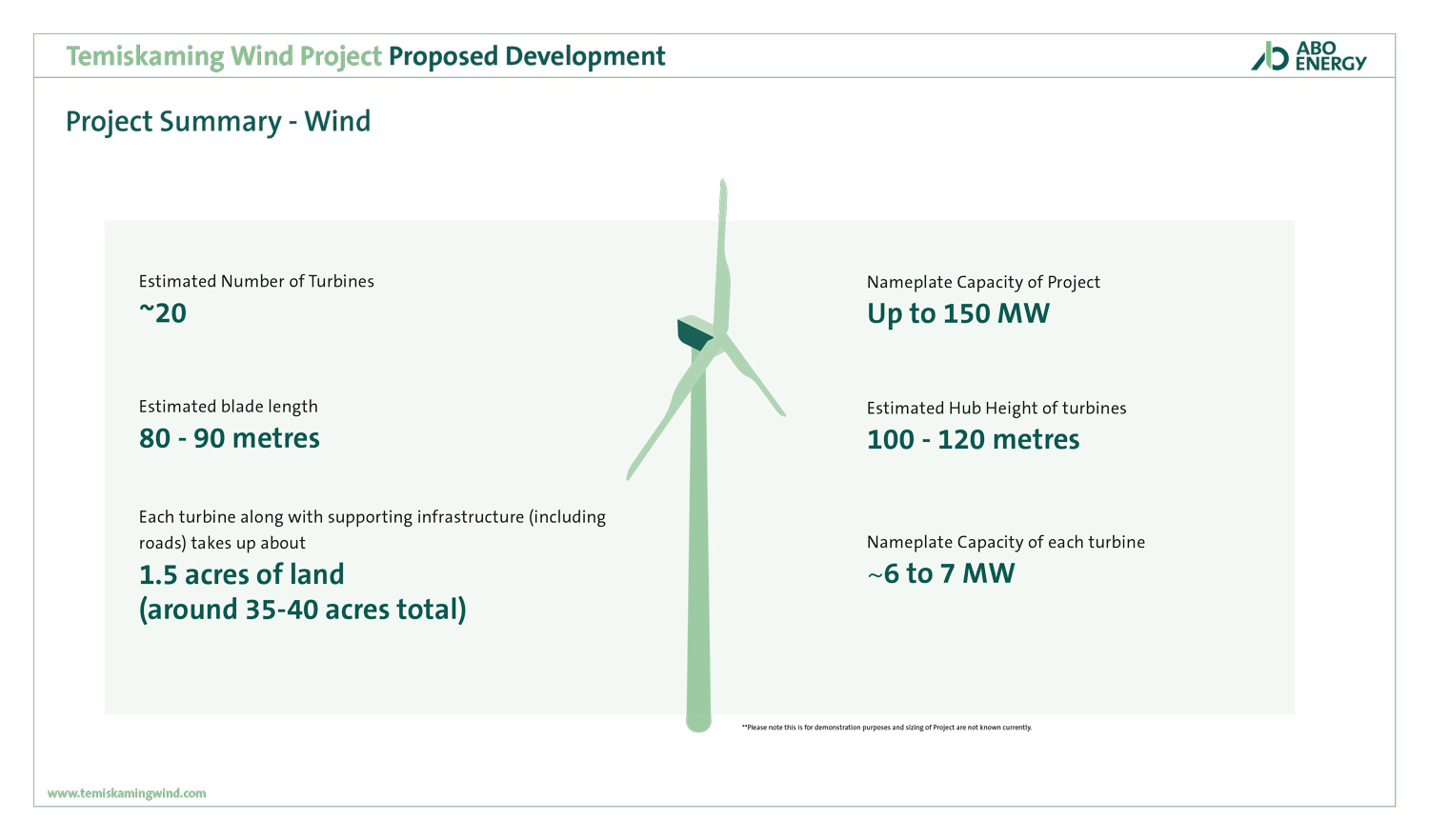

Project Components

Land and Site Control

Interconnection and Grid Access

Project Timeline

Download

Market Opportunity / Provincial Context

IESO Long Term 2 (LT2) Request for Proposal (RFP): IESO is launching a new procurement program to procure 5000MW of new generation and 1,600MW of capacity over the next four years. RFP submissions windows expected Q3/Q4 each year from 2025-2028. ABO Energy plans to submit the Timiskaming Wind Project into the tender process in October 2025. Additional information can be found here: Long-Term 2 RFP

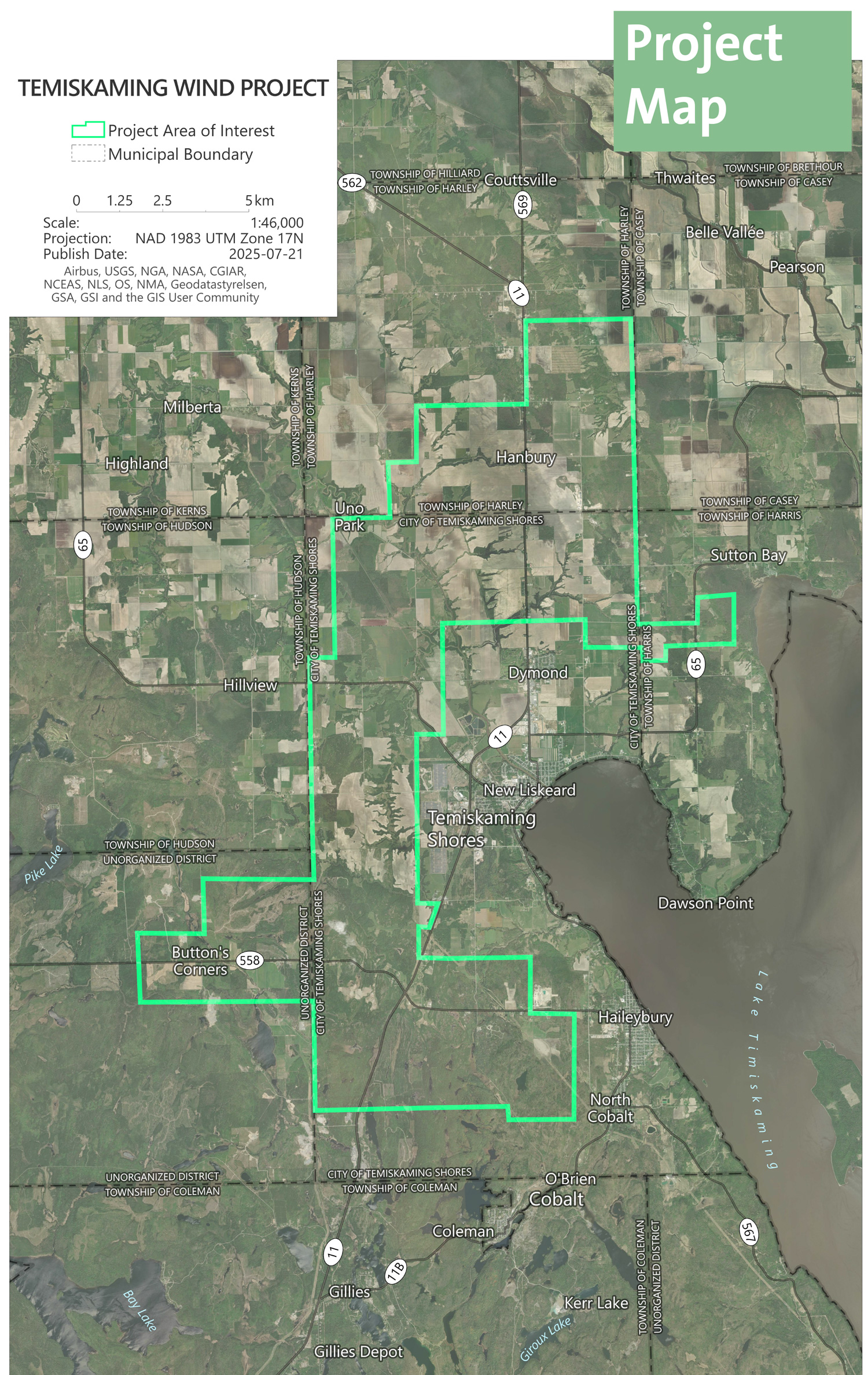

Project Development Area (MAP) / Zone of Investigation

Land for the Project has not been finalized. ABO Energy is currently signing lands within the following Area of Interest.

Temiskaming

Environmental Permitting

Pre-RFP Submission

Environmental permits are not required to be submitted for the RFP. However, ABO Energy is undertaking preliminary studies to assess impact including:

Post RFP Submission

If the RFP is successful, Renewable Energy Approval Report Requirements would include:

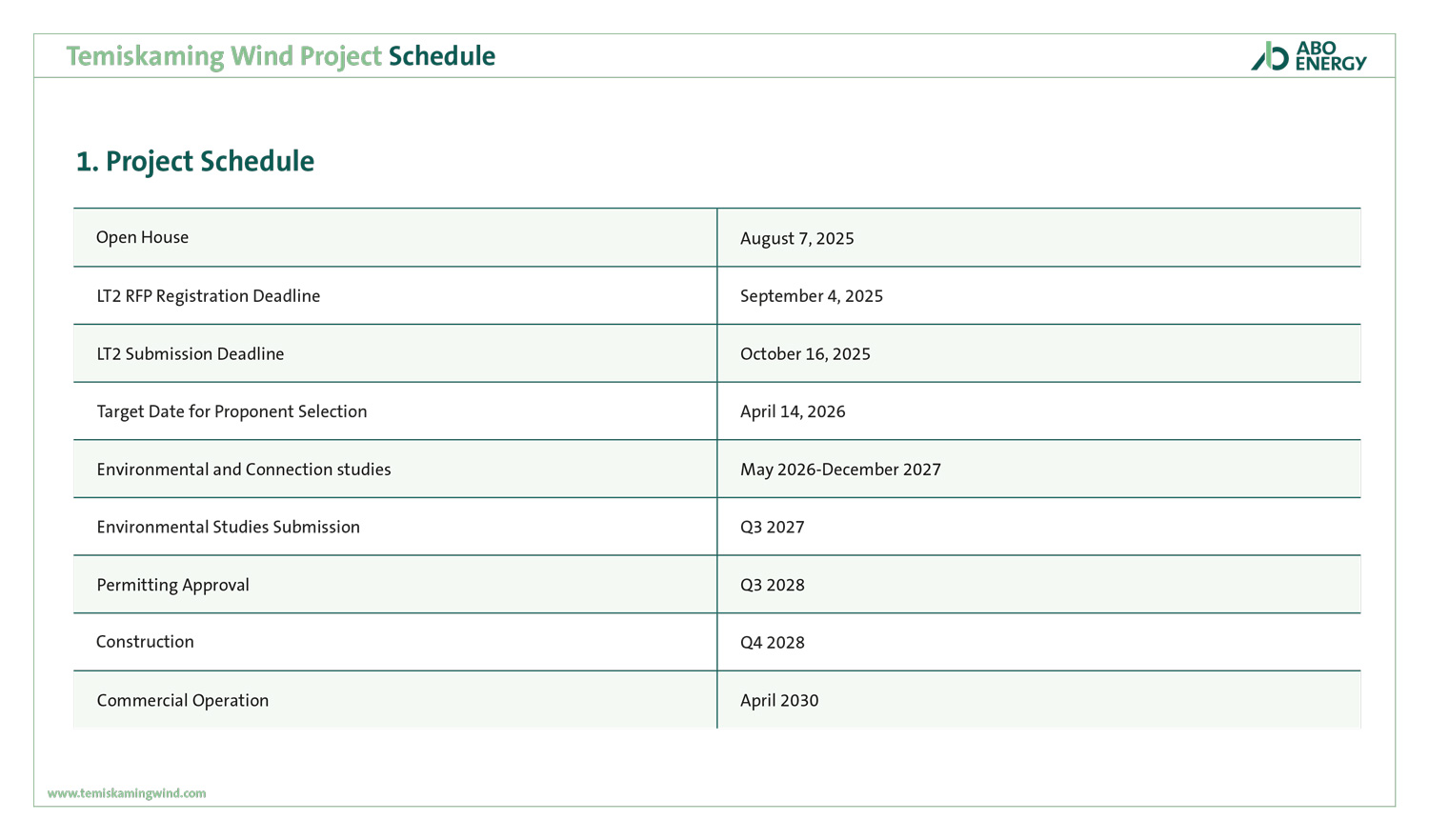

Schedule

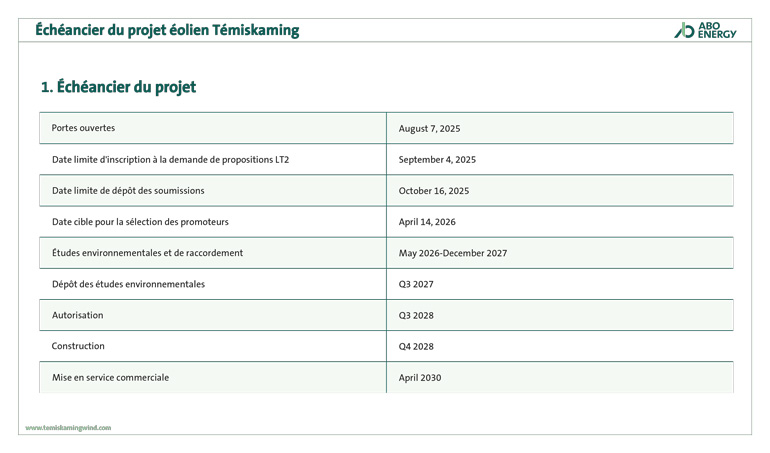

Project Schedule
Winter 2025/2026 MET Tower Installation
Spring 2026 LT2 Window 2 Registration
Summer 2026 Window 2 Submission Deadline
End of 2026 Target Date for Proponent Selection
2027 Environmental and Connection Studies
Q1 2028 Environmental Permit Submission
Q1 2029 Permitting Approval
Q2 2029 Construction Start
Winter 2030/2031 Commercial Operation

Project schedule is subject to change.

Community Benefits

Community Benefit Fund

ABO Energy intends to create a community benefit fund via revenue generated by the project. Scope of the benefit to be discussed with the municipality(s) but would be relative to the project size and proportional to project lands hosted by each municipality.

Tax Revenue

The project would generate substantial tax revenue for the Municipality.

Employment

Preferences will be given to local venders and businesses.

Supports Sustainable Initiatives

The Wind Project will conservatively generate 275,940 MW/h of renewable energy per year, the equivalent of 29,000 homes in Ontario.

Vendors and Suppliers

If you are a Vendor interested in providing your goods and/or services to ABO Energy Canada Ltd. we ask that you submit your company information via our ‘Supplier Registration Form’ located here:

Contact

Jon Clifford

Senior Project Manager

Jon Clifford

Tel. +1 (416) 220-6691
jon.clifford(at)aboenergy.com

Dave Berrade

Social Impact and Engagement Lead

Dave Berrade

Tel. +1 (587) 576-5339
dave.berrade(at)aboenergy.com
